INVESTMENTS
Construction Impact documents for the North Avenue Rising project can be found below.
- North Avenue Construction Impacts

- Baker St - St. Stephens St to North Bentalou St
- Baker St - Ruxton Ave to North Fulton Ave
- Baker St - North Mount St to Druid Hill Ave
- 20th St - Guilford Ave to Kennedy Ave
- 20th St - Maryland Ave to Guilford Ave
2022
- North Avenue Construction Impacts

- Baker St - St. Stephens St to North Bentalou St
- Baker St - Ruxton Ave to North Fulton Ave
- Baker St - North Mount St to Druid Hill Ave
- 20th St - Guilford Ave to Kennedy Ave
- 20th St - Maryland Ave to Guilford Ave

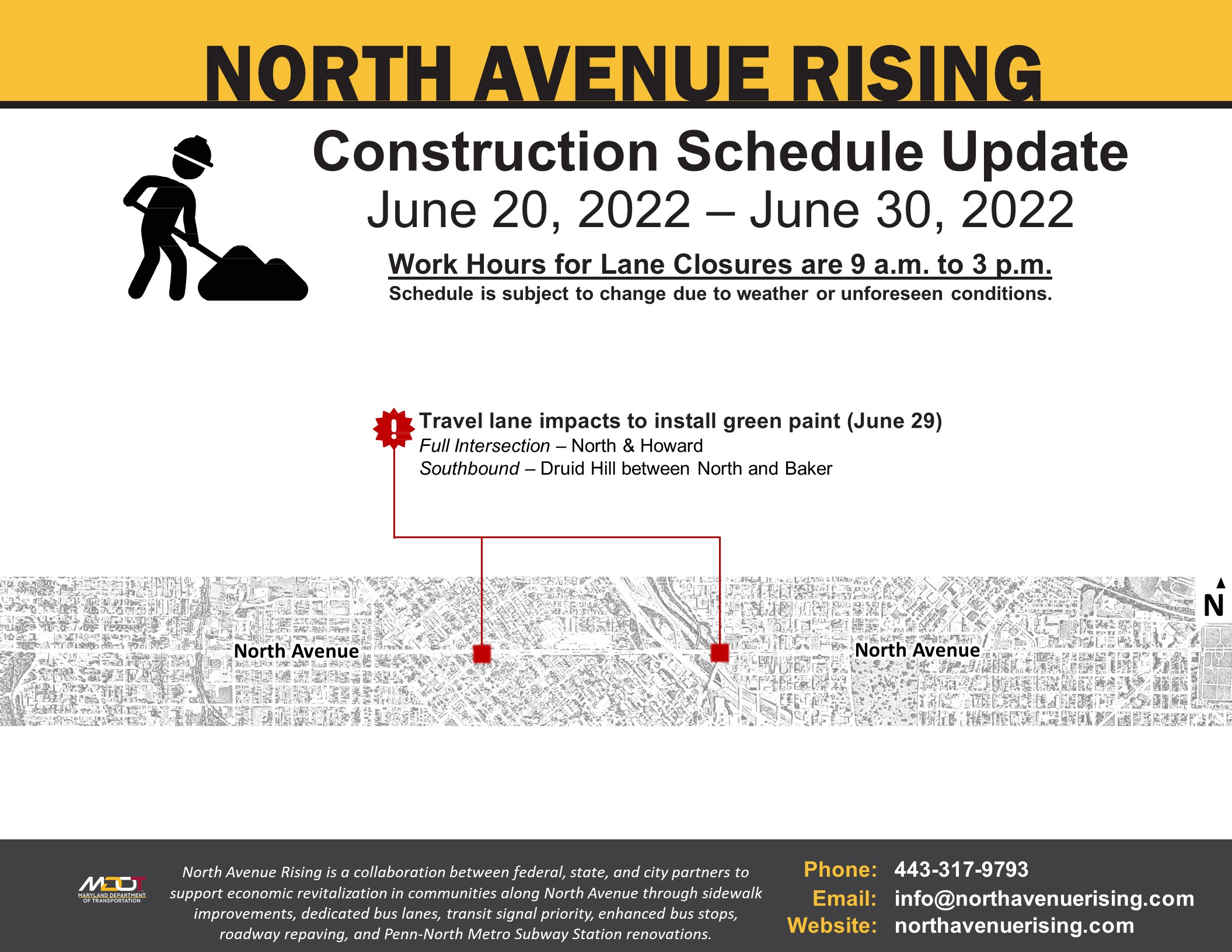

- North Avenue Construction Impacts - June 20 - June 30

- North Avenue Construction Impacts - May 23 - June 4

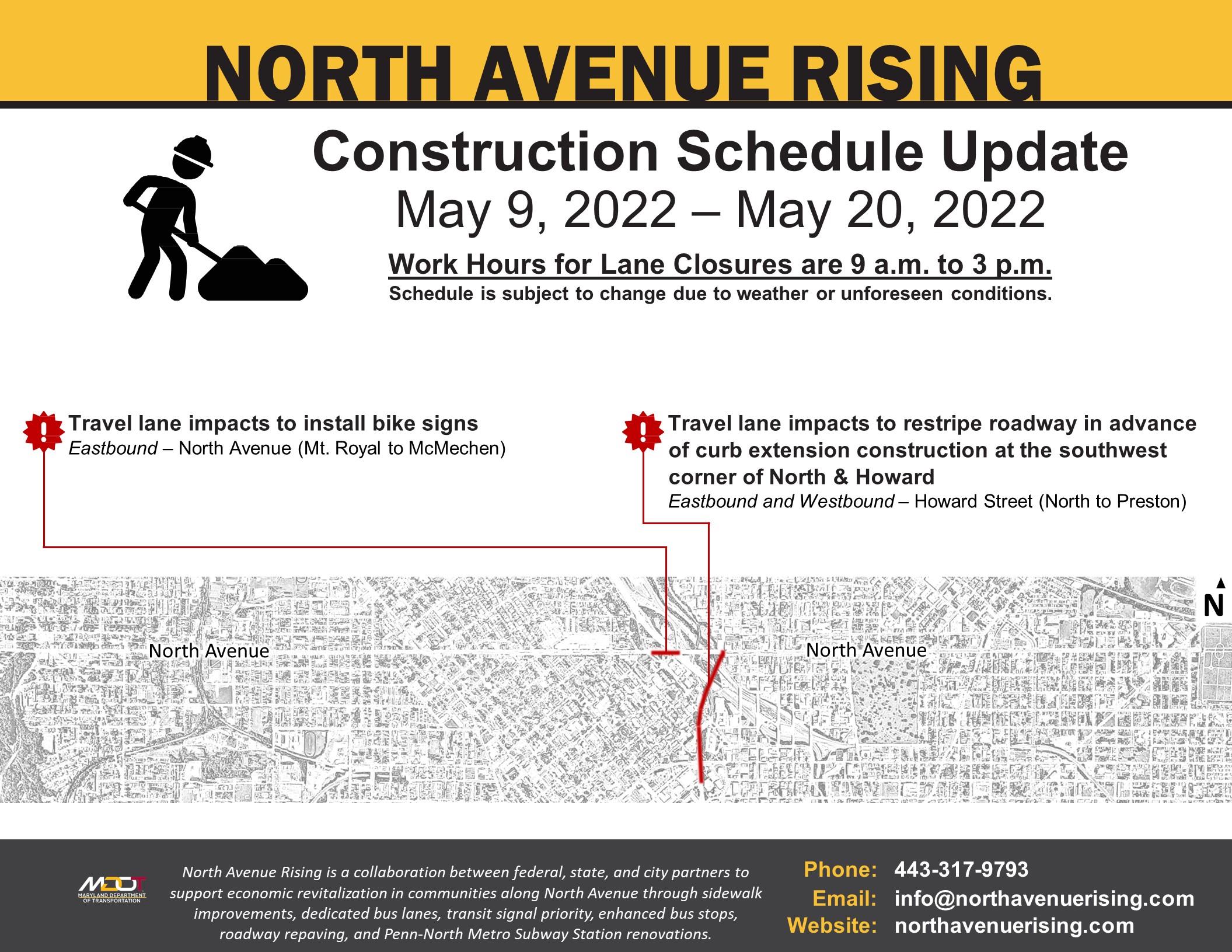

- North Avenue Construction Impacts - May 9 - May 20

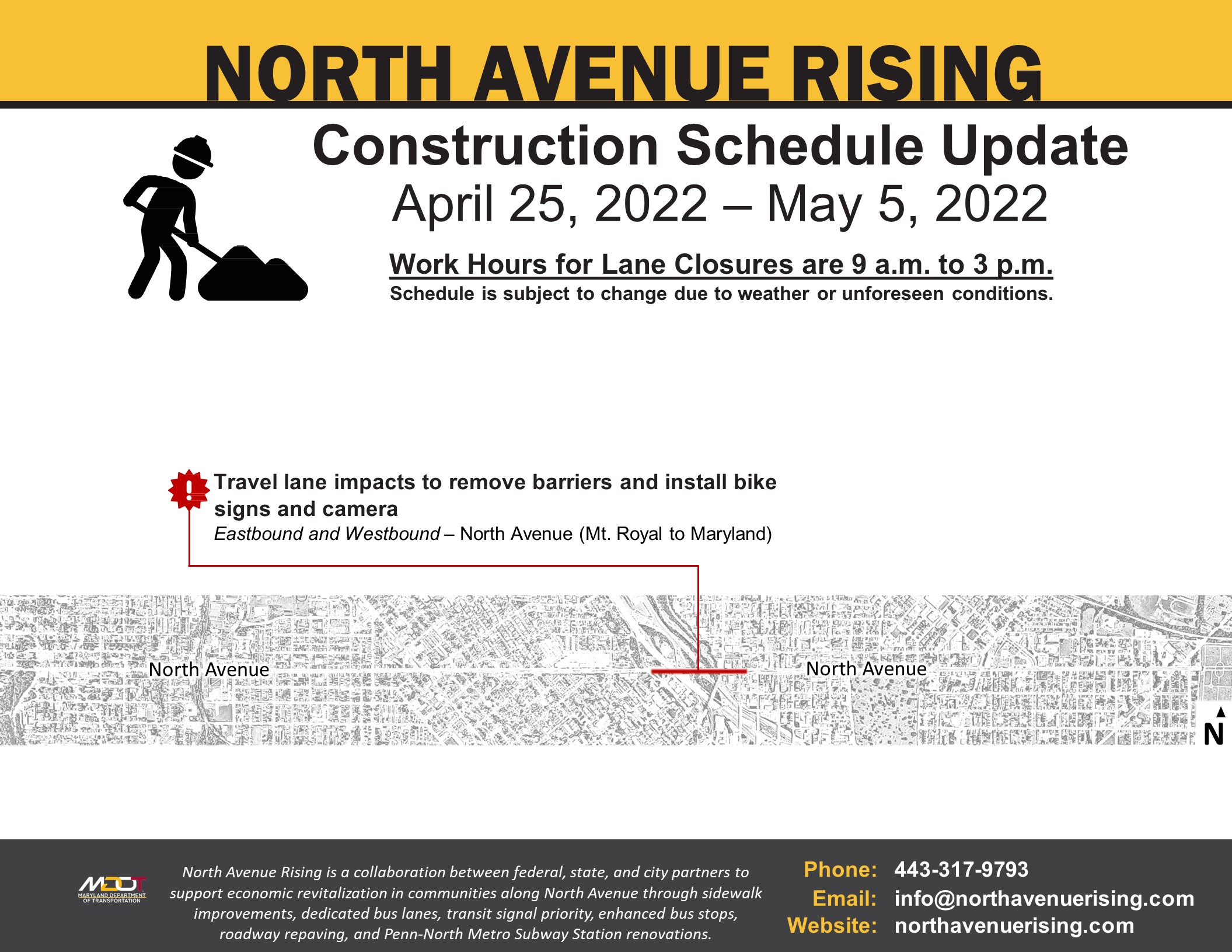

- North Avenue Construction Impacts - Apr 25 - May 5

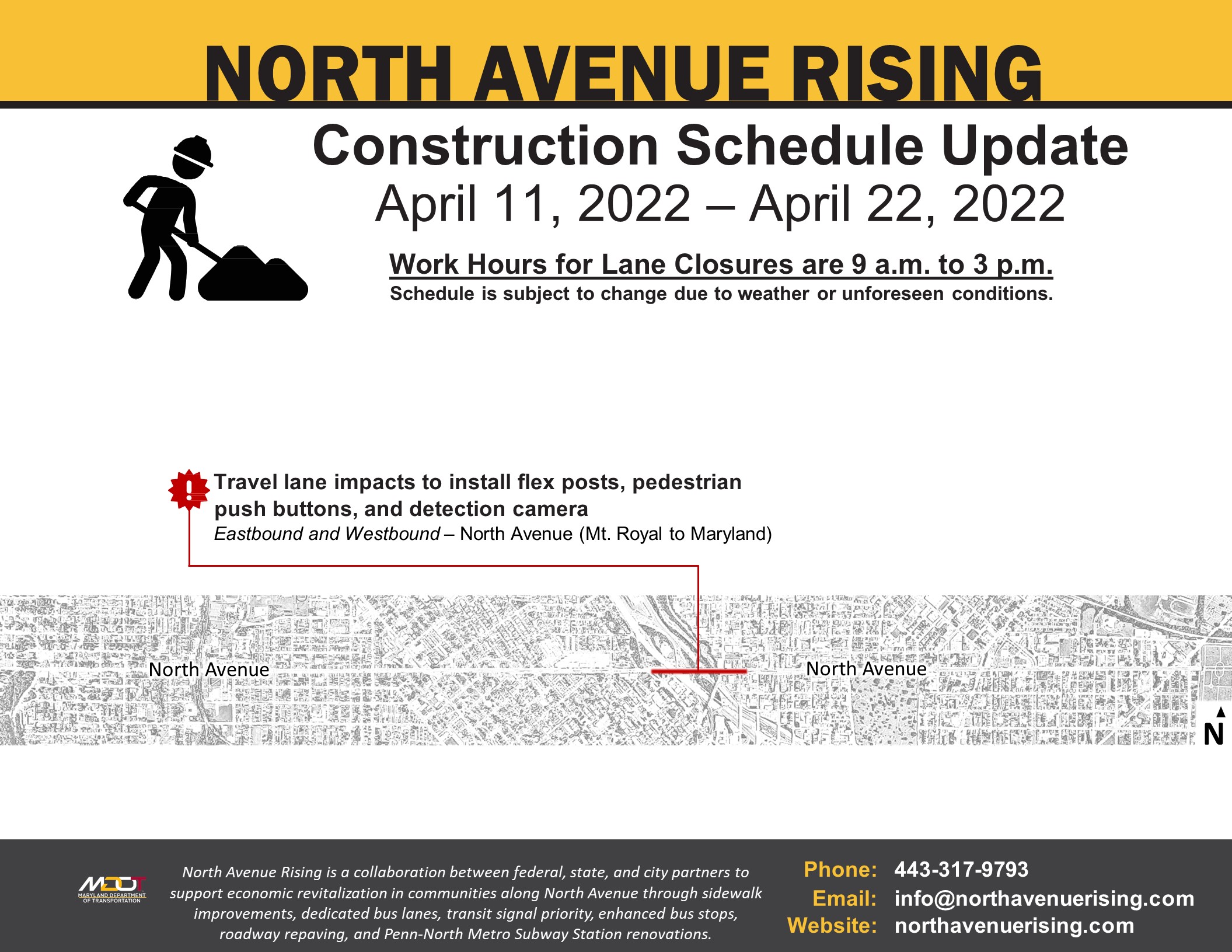

- North Avenue Construction Impacts - Apr 11 - Apr 22

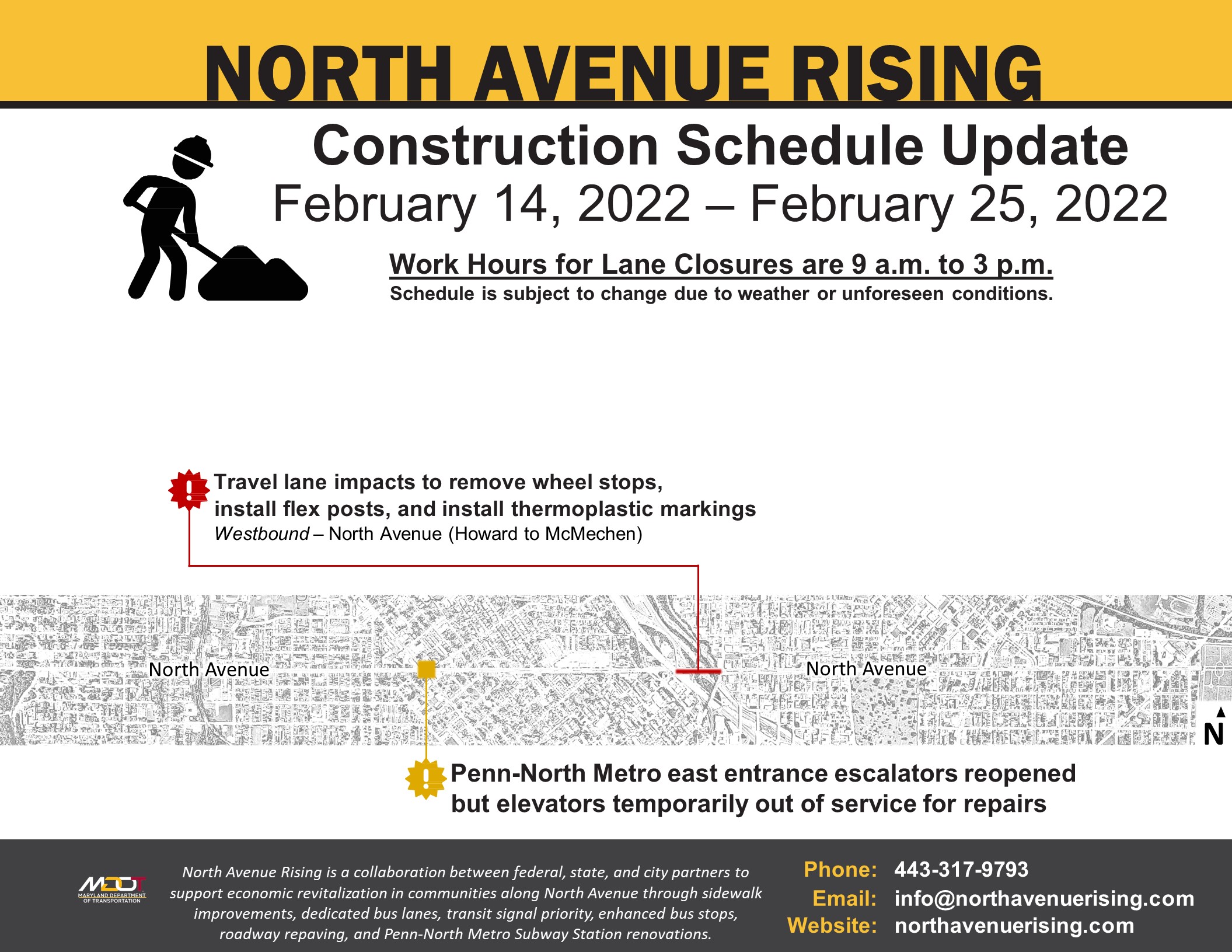

- North Avenue Construction Impacts - Feb 14 - Feb 25

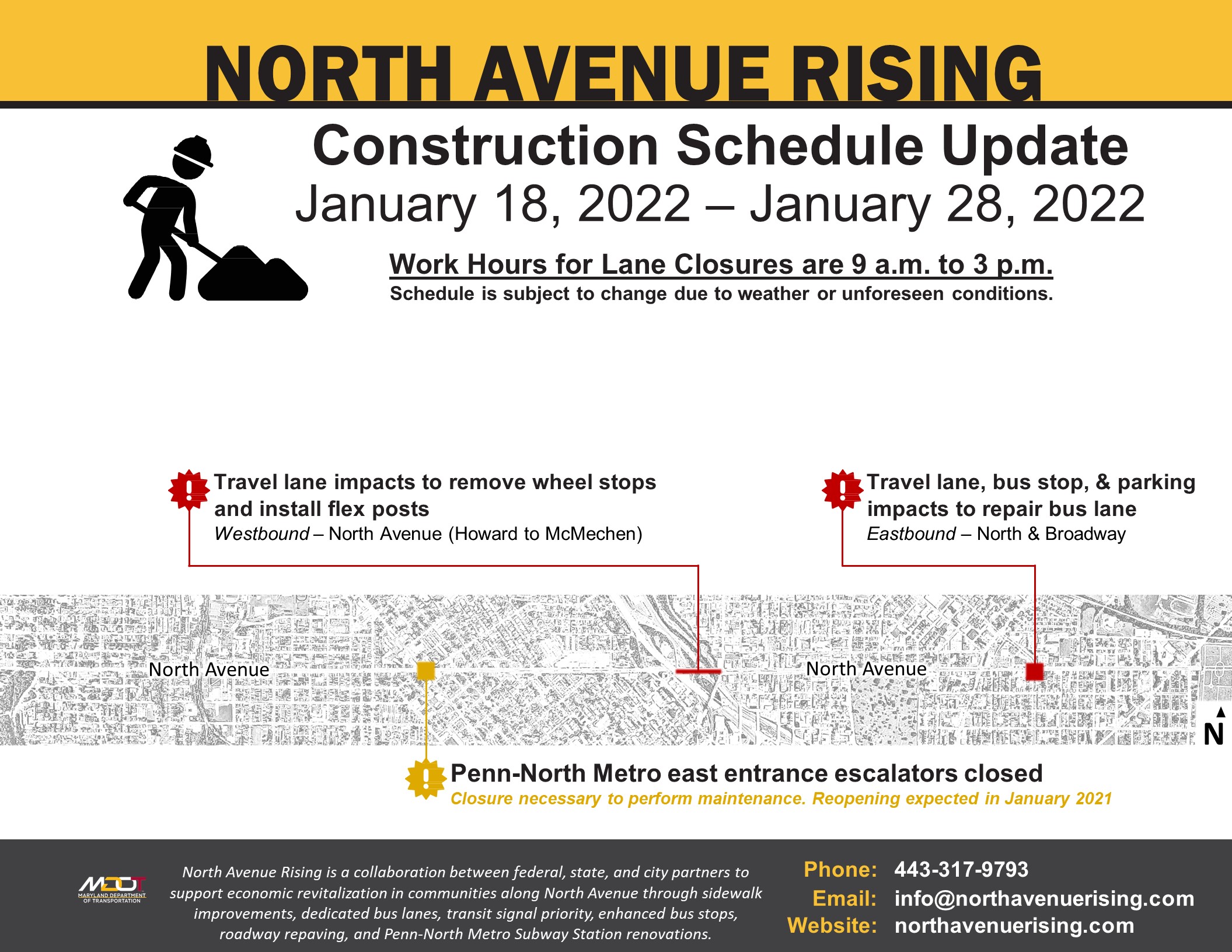

- North Avenue Construction Impacts - Jan 18 - Jan 28

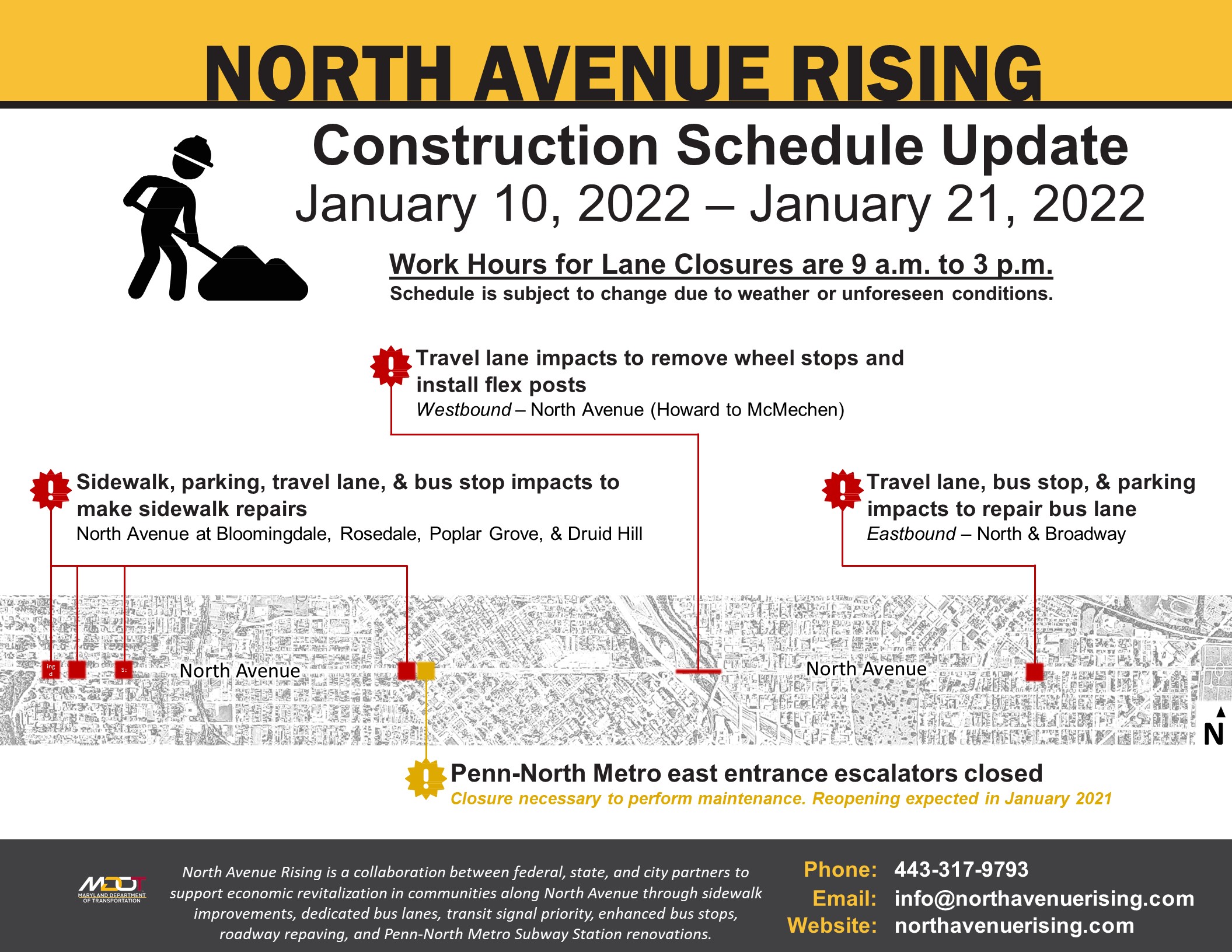

- North Avenue Construction Impacts - Jan 10 - Jan 21, 2022

2021

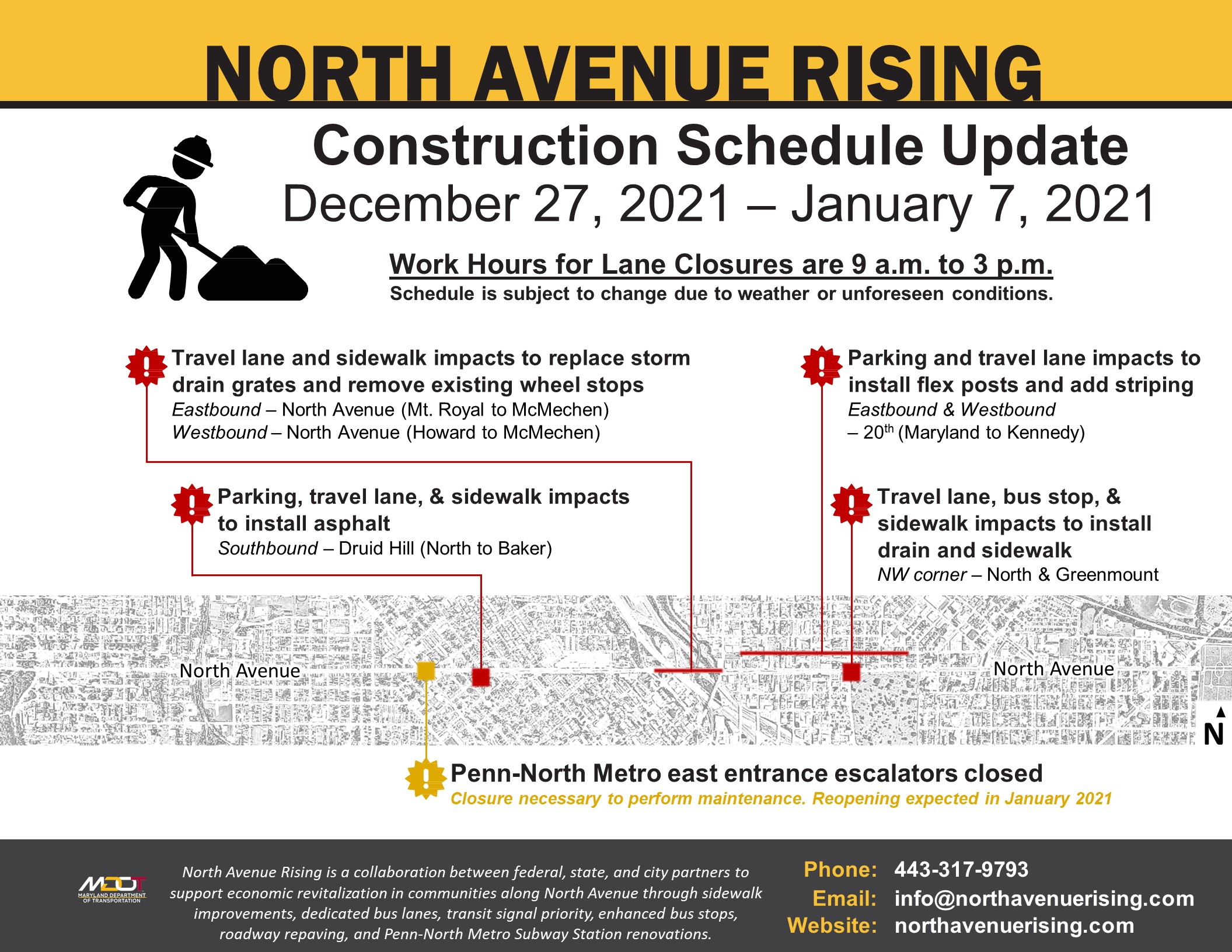

- North Avenue Construction Impacts - Dec 27 - Jan 7, 2022

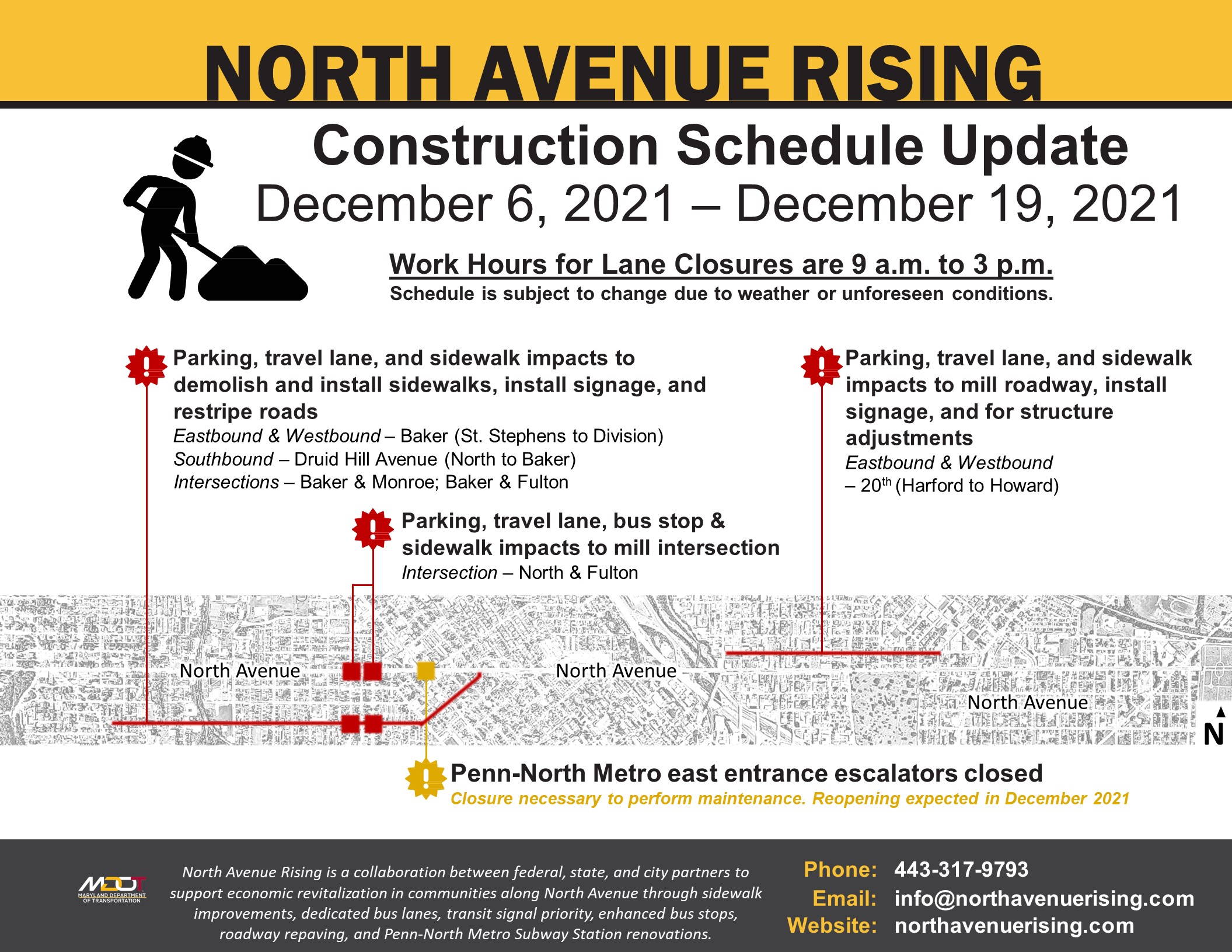

- North Avenue Construction Impacts - Dec 6 - Dec 19

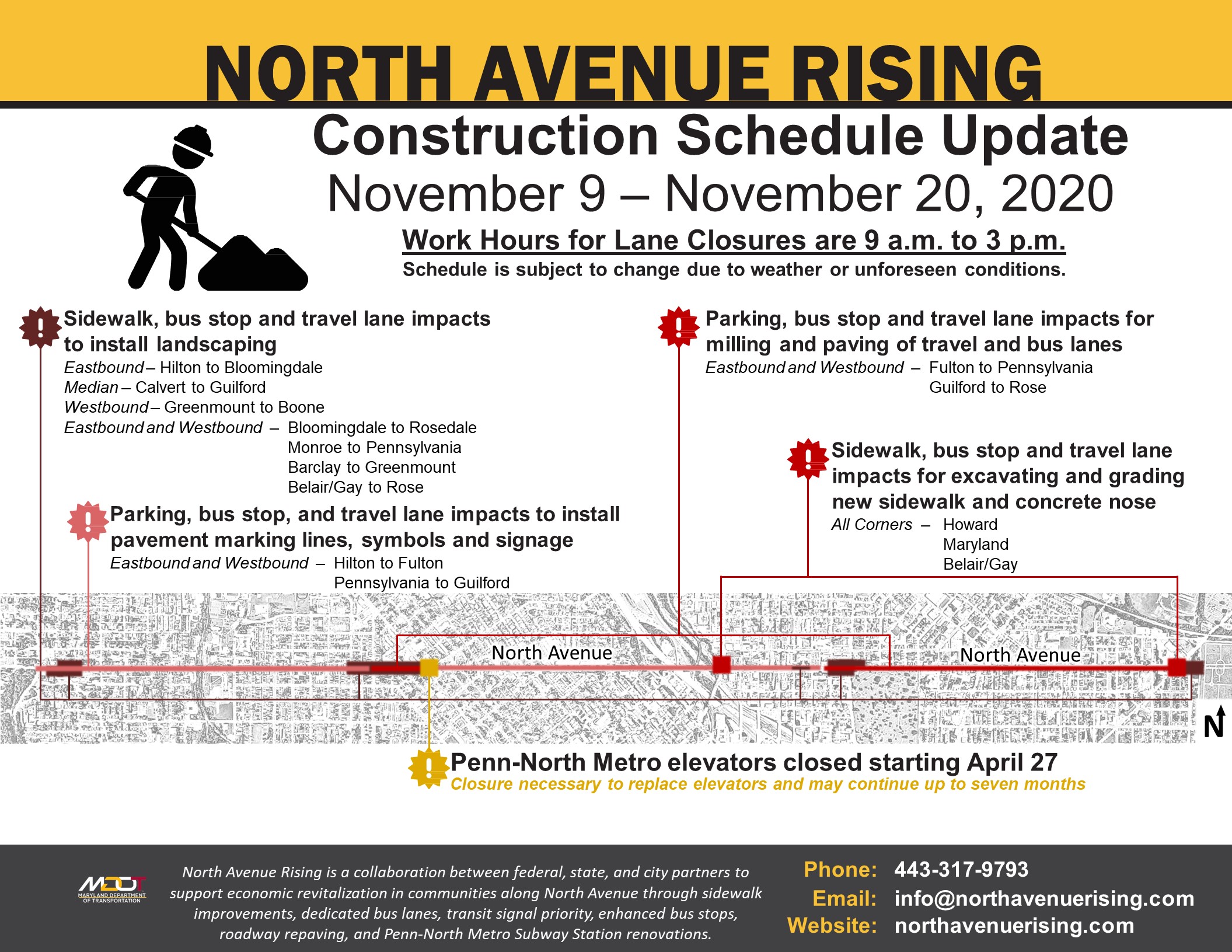

- North Avenue Construction Impacts - Nov 8 - Nov 20

- North Avenue Construction Impacts - Nov 1 - Nov 13

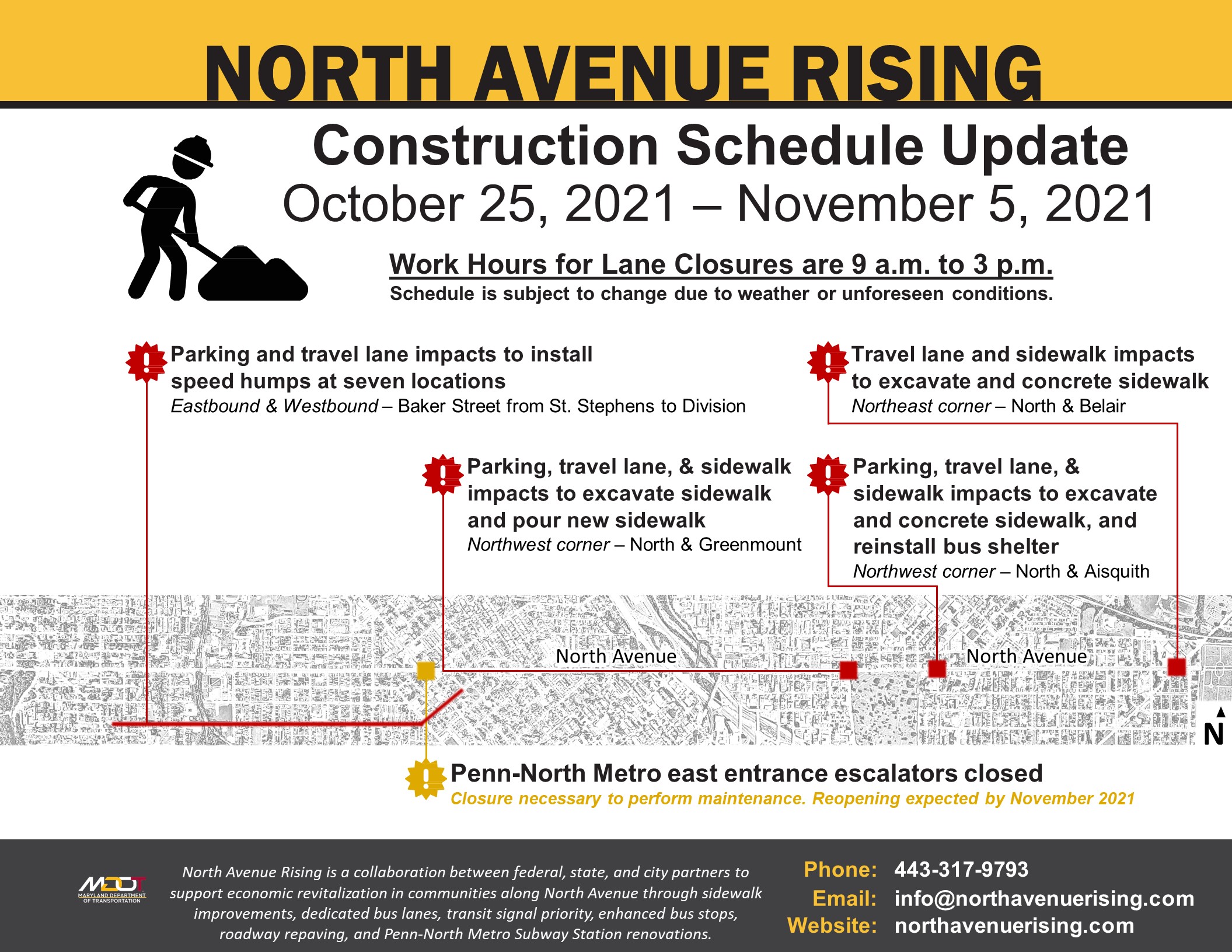

- North Avenue Construction Impacts - Oct 25 - Nov 5

- North Avenue Construction Impacts - Oct 18 - Oct 29

- North Avenue Construction Impacts - Sept 27 - Oct 8

- North Avenue Construction Impacts - Sept 20 - Oct 1

- North Avenue Construction Impacts - Sept 13 - Sept 24

- North Avenue Construction Impacts - Sept 7 - Sept 17

- North Avenue Construction Impacts - Aug 30 - Sept 10

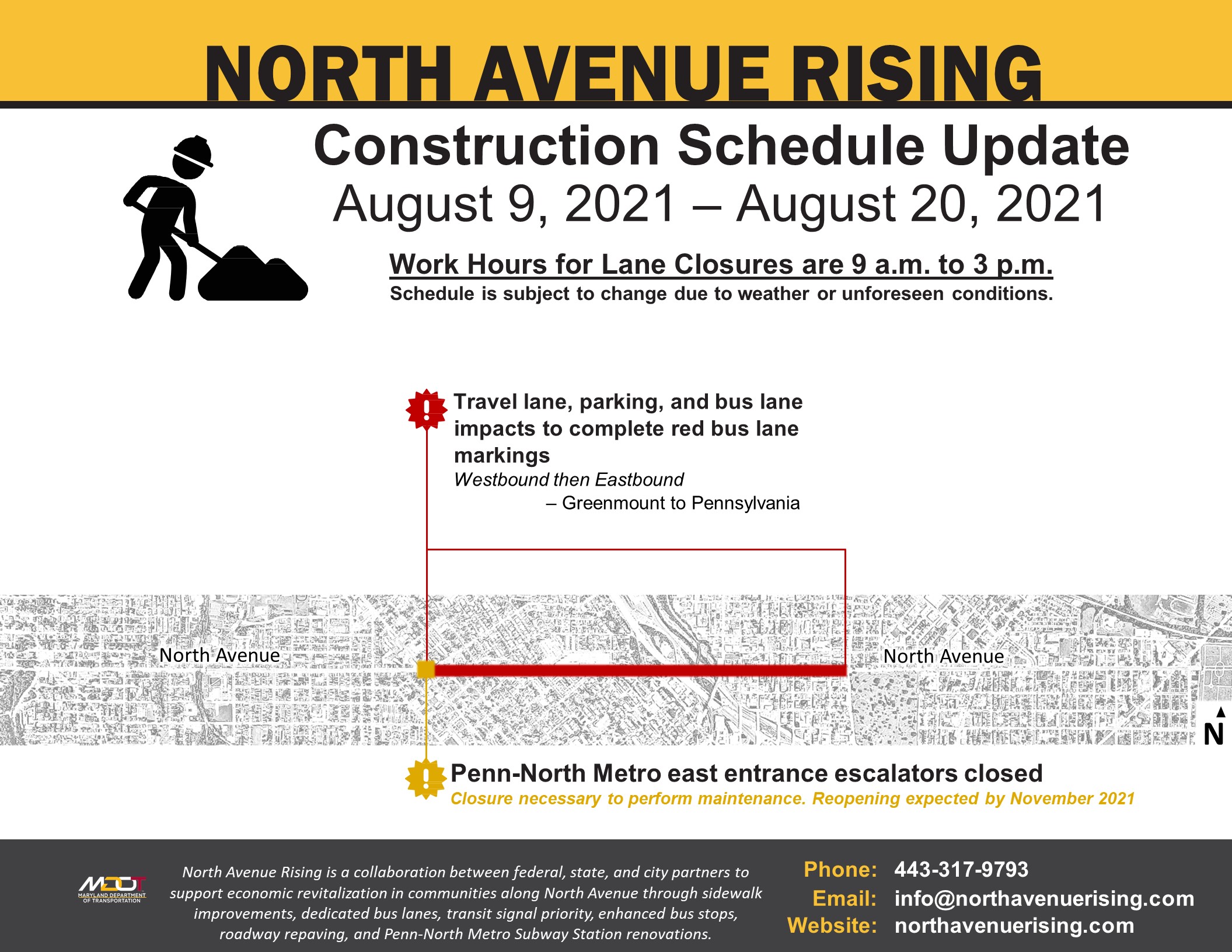

- North Avenue Construction Impacts - Aug 9 - Aug 20

- North Avenue Construction Impacts - Aug 2 - Aug 13

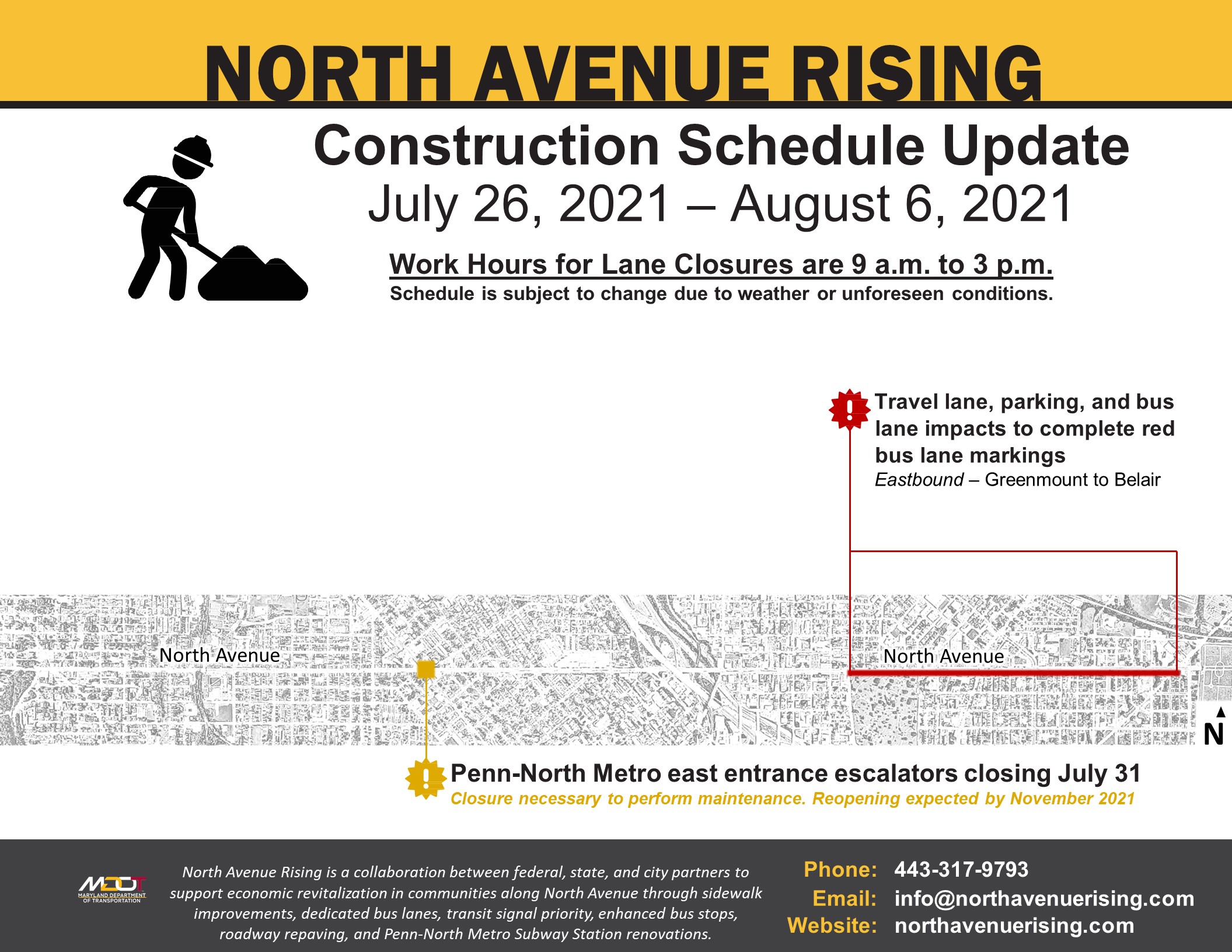

- North Avenue Construction Impacts - July 26 - Aug 6

- North Avenue Construction Impacts - July 12 - July 23

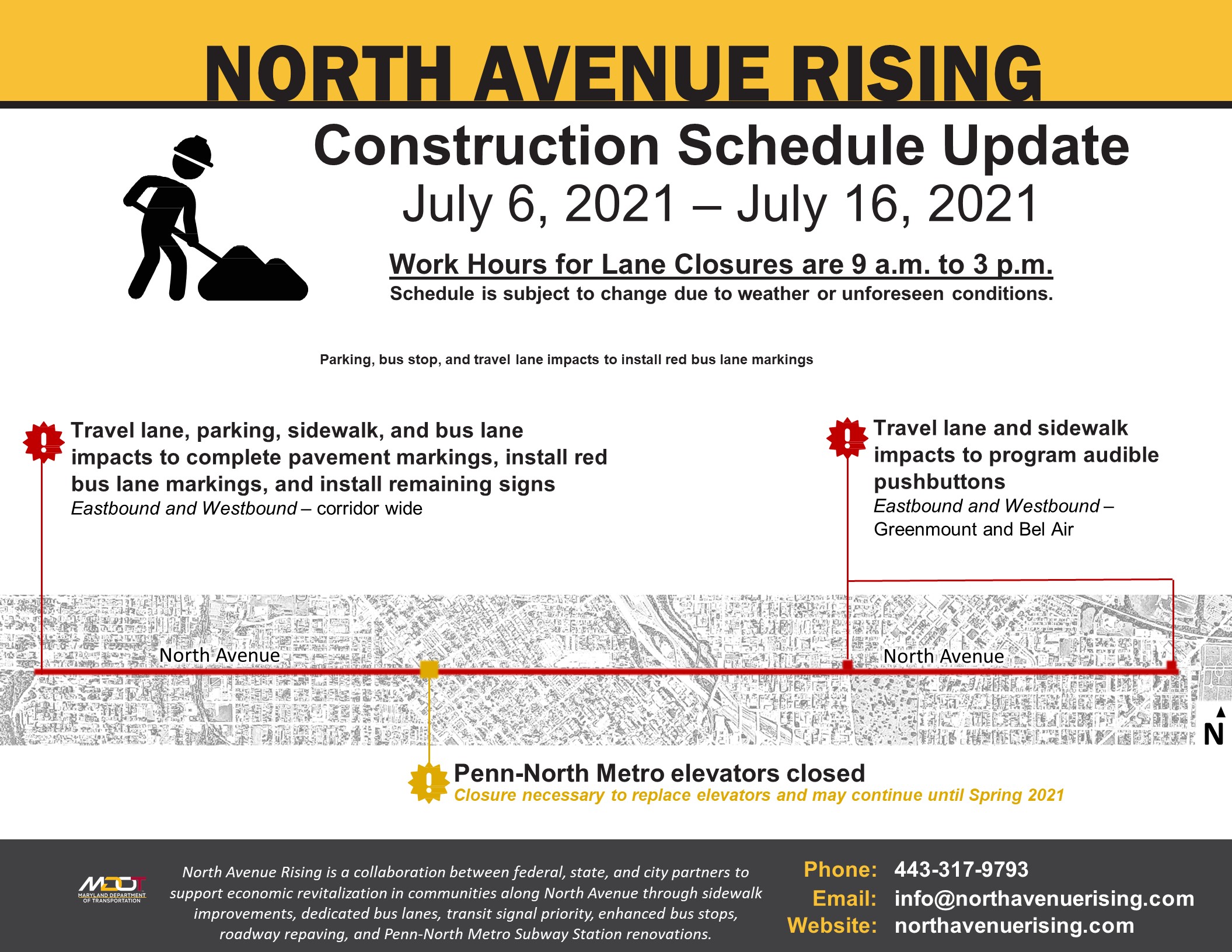

- North Avenue Construction Impacts - July 6 - July 16

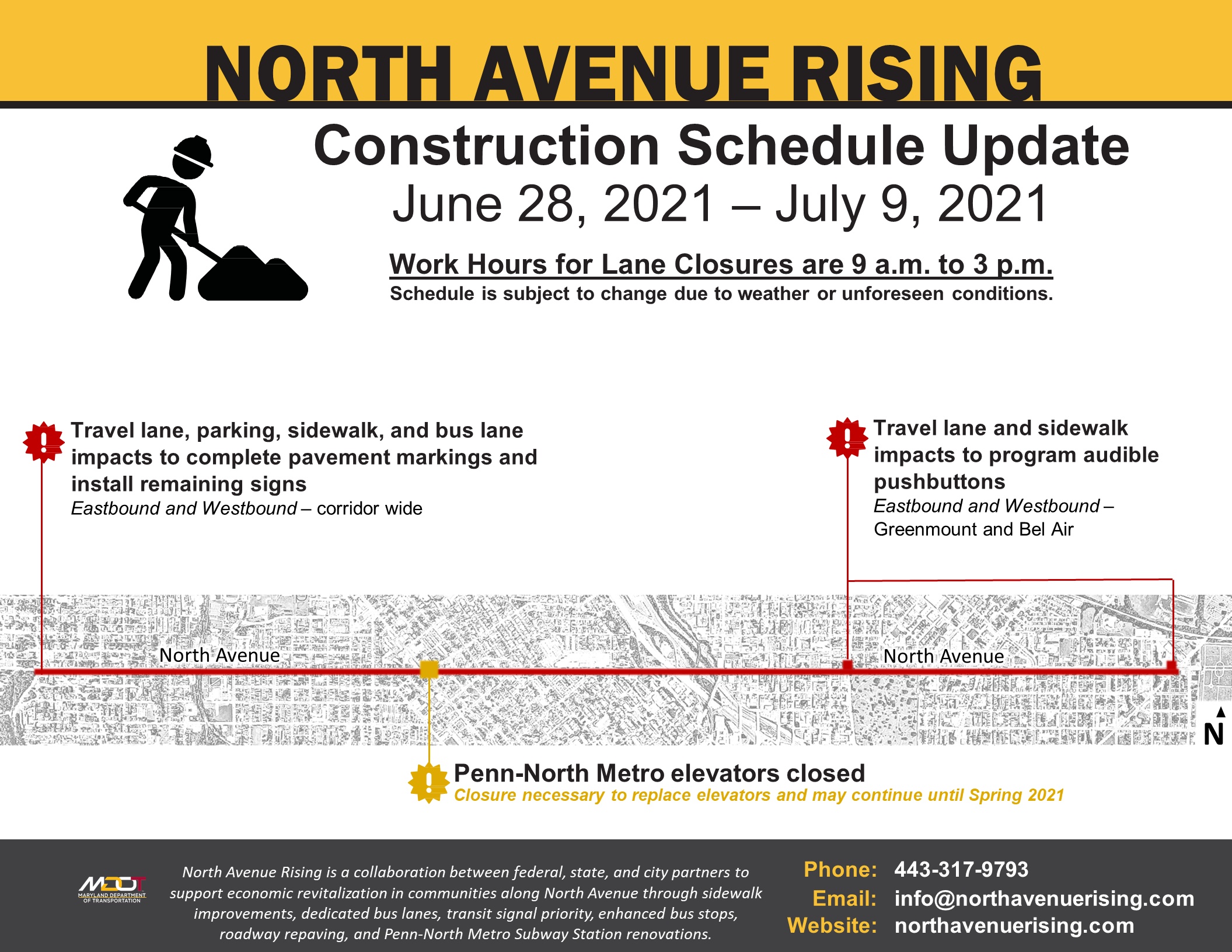

- North Avenue Construction Impacts - June 28 - July 9

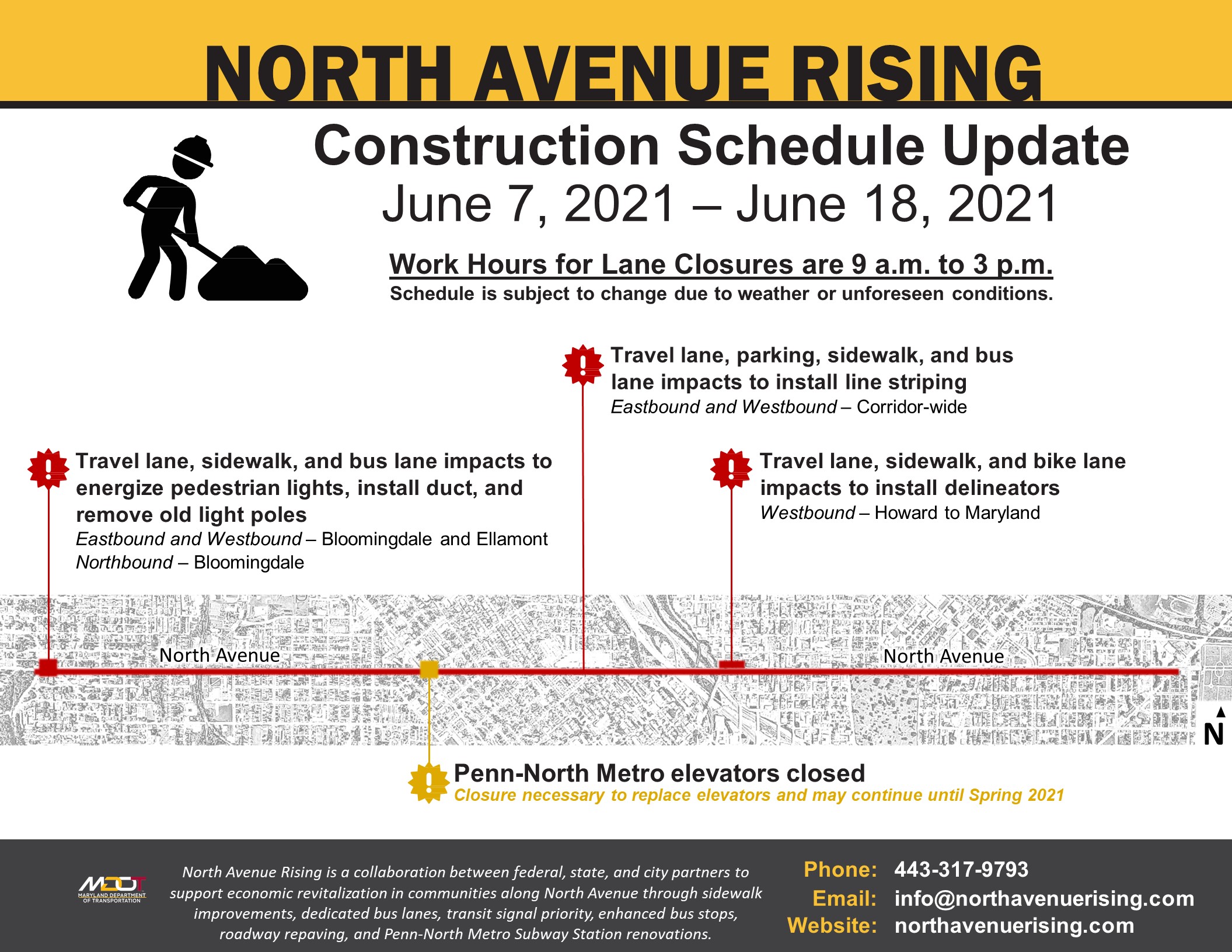

- North Avenue Construction Impacts - June 7 - June 18

- North Avenue Construction Impacts - June 1 - June 11

- North Avenue Construction Impacts - May 24 - June 4

- North Avenue Construction Impacts - May 10 - May 21

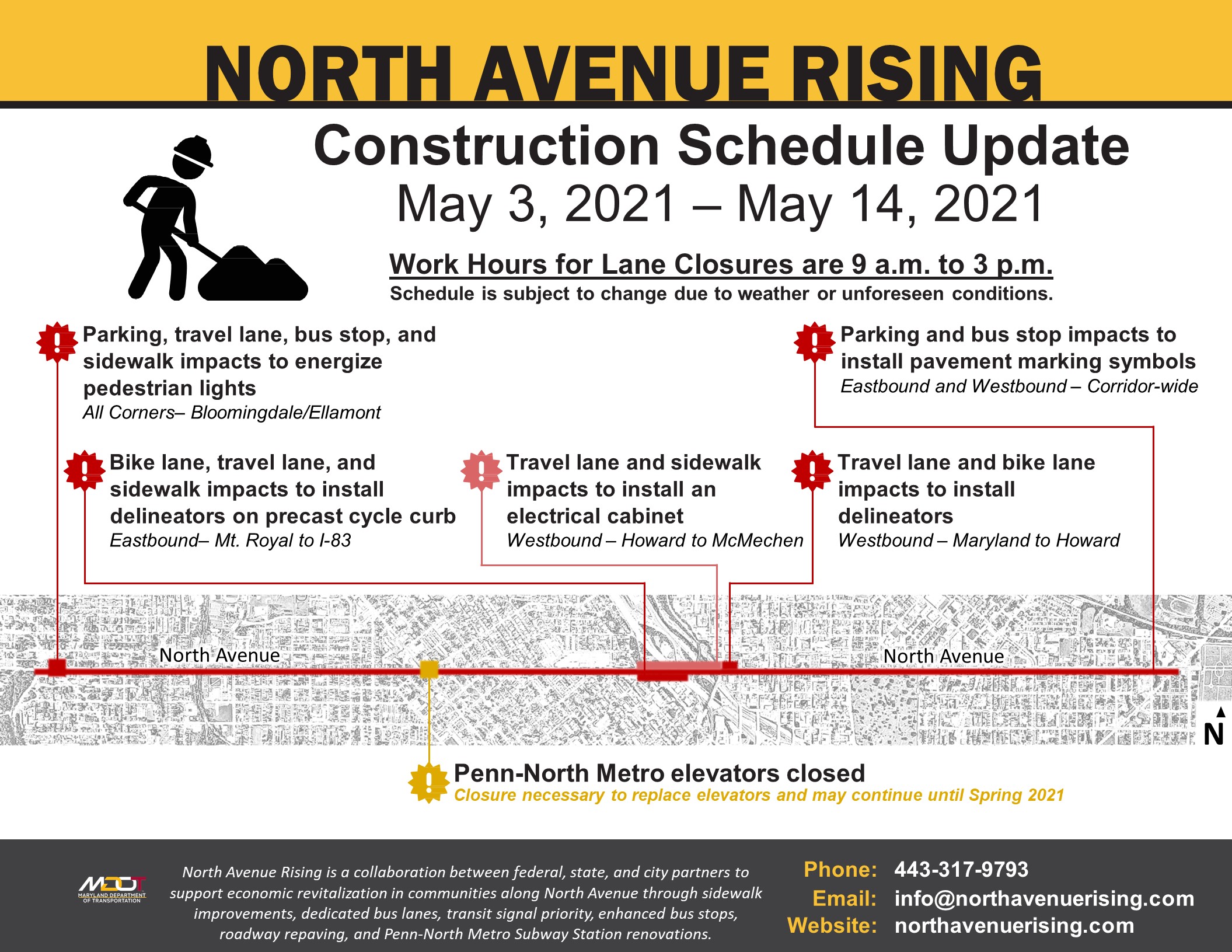

- North Avenue Construction Impacts - May 3 - May 14

- North Avenue Construction Impacts - Apr 26 - May 7

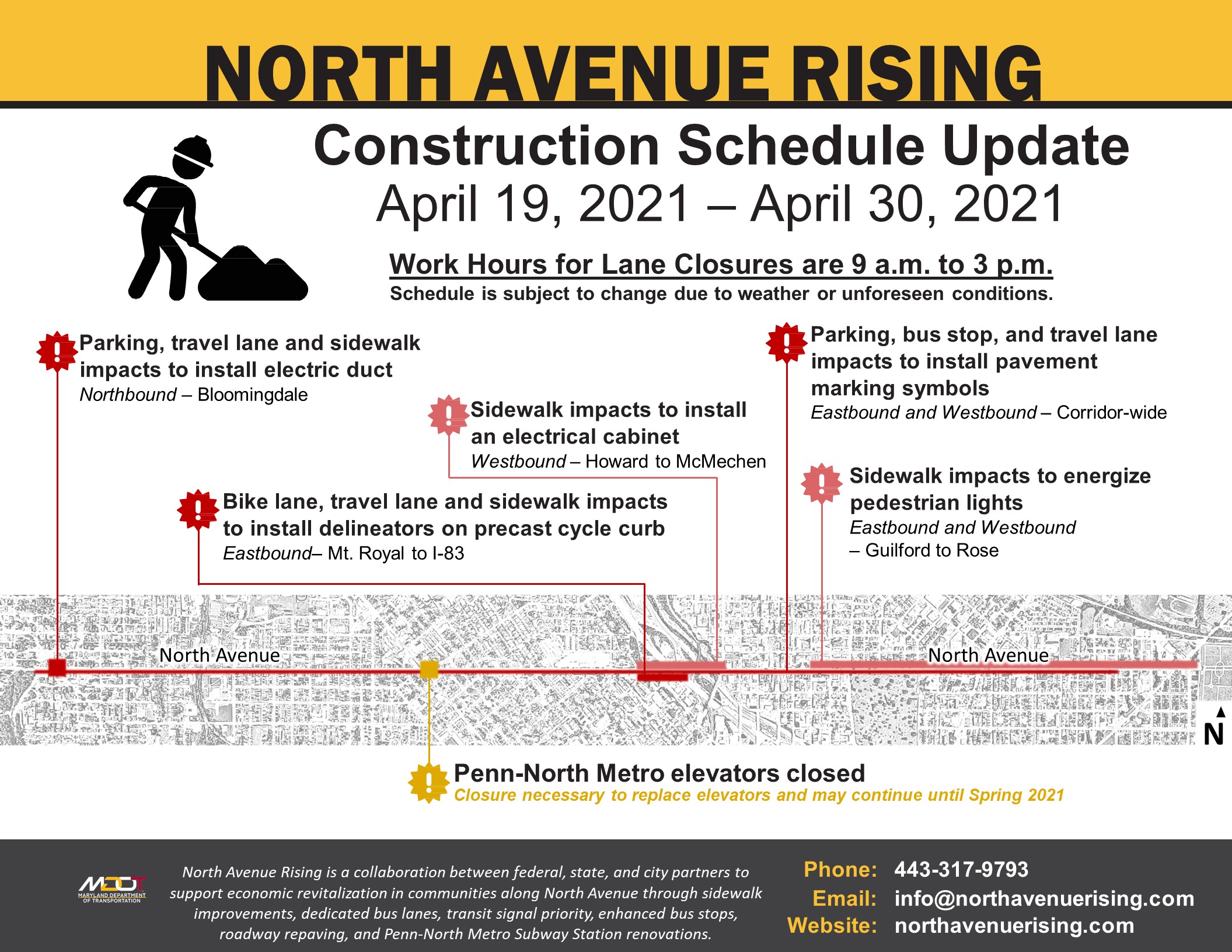

- North Avenue Construction Impacts - Apr 19 - Apr 30

- North Avenue Construction Impacts - Apr 12 - Apr 23

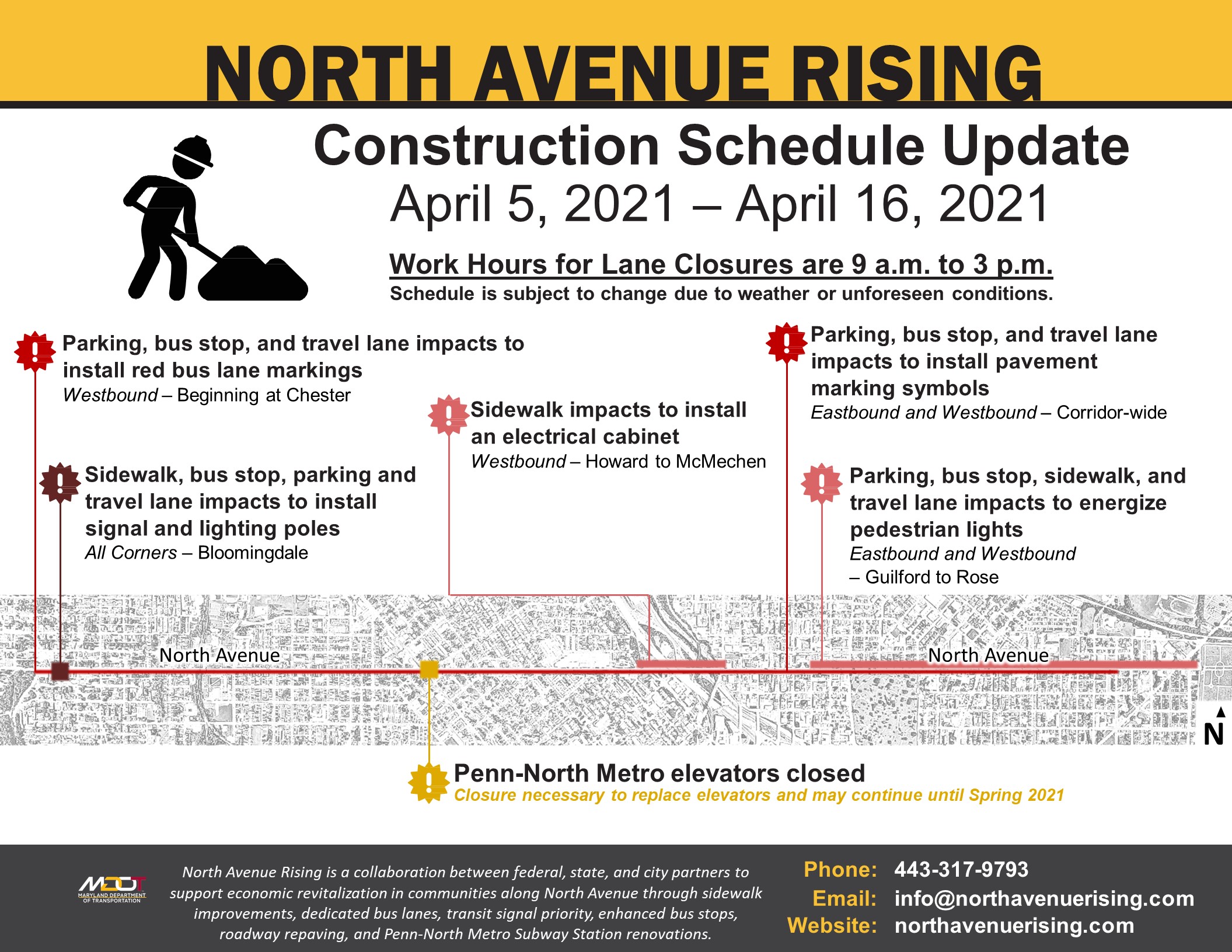

- North Avenue Construction Impacts - Apr 5 - Apr 16

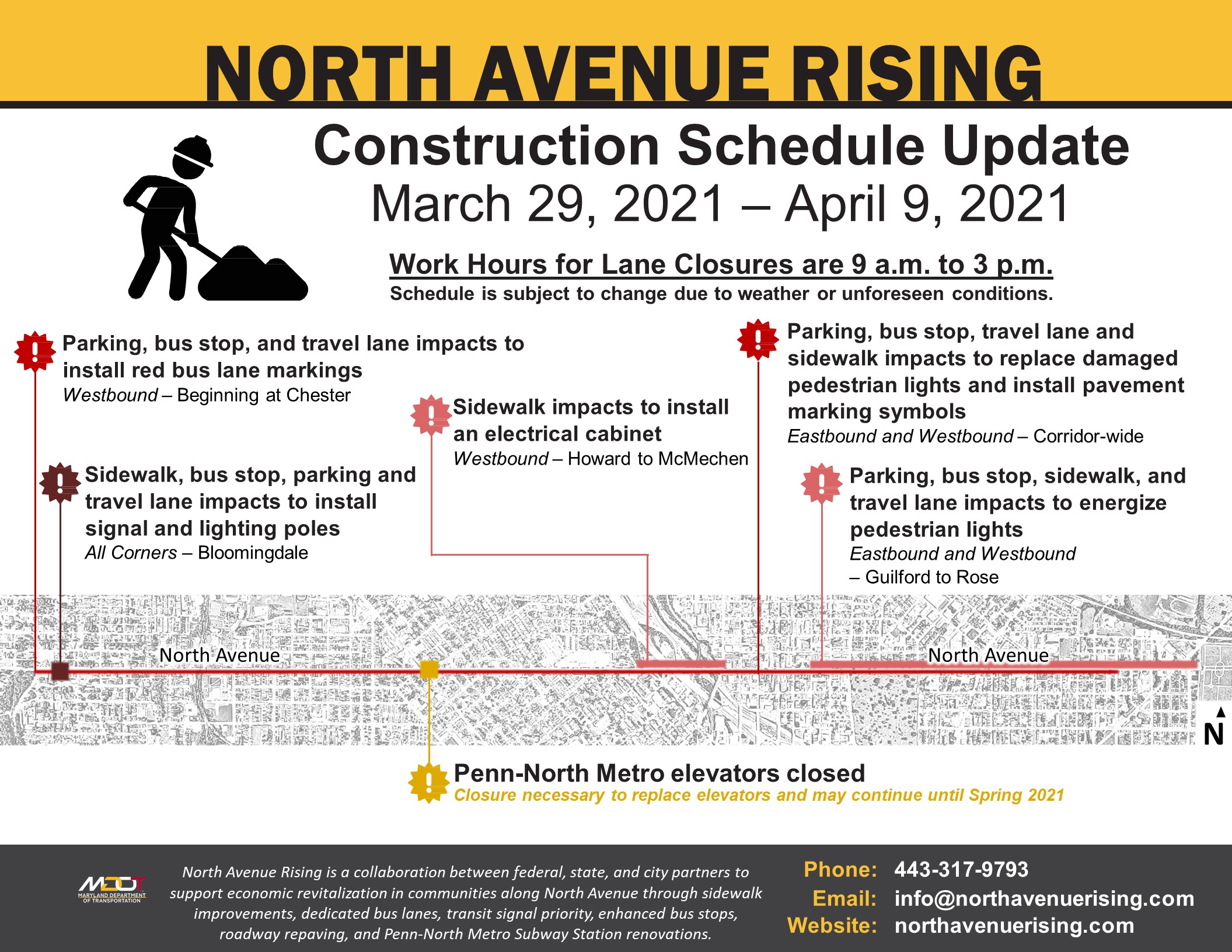

- North Avenue Construction Impacts - Mar 29 - Apr 9

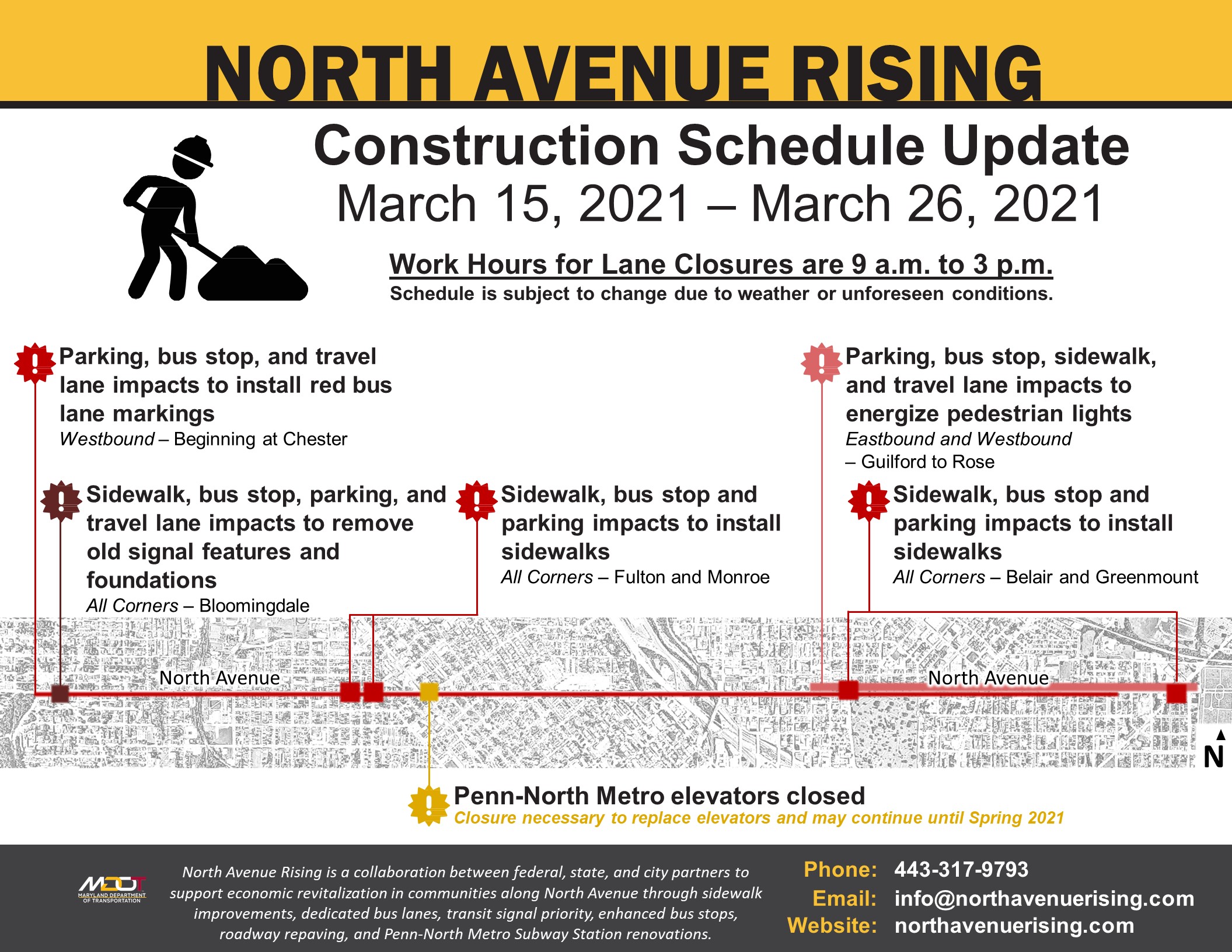

- North Avenue Construction Impacts - Mar 15 - Mar 26

- North Avenue Construction Impacts - Mar 8 - Mar 19

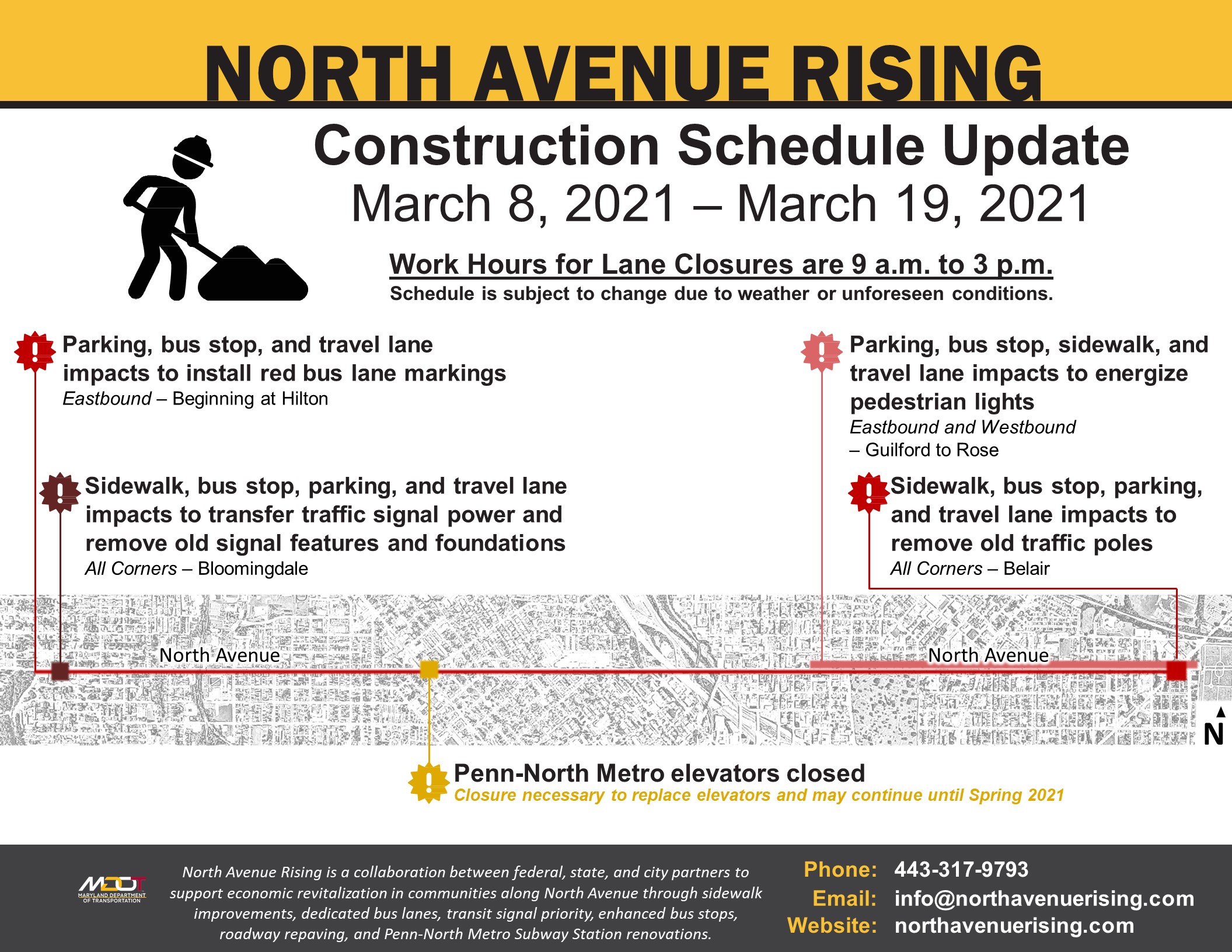

- North Avenue Construction Impacts - Mar 1 - Mar 12

- North Avenue Construction Impacts - Feb 16 - Feb 26

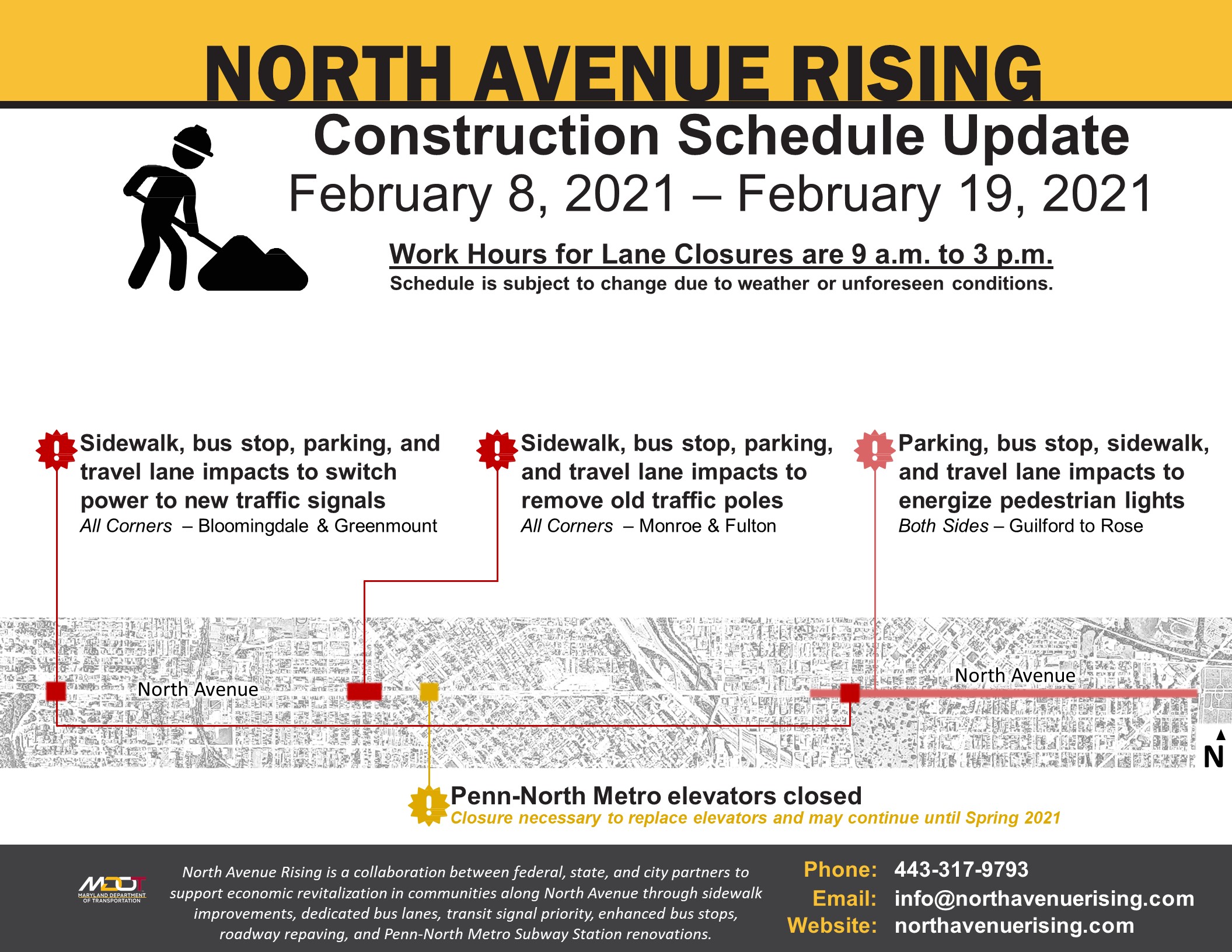

- North Avenue Construction Impacts - Feb 8 - Feb 19

- North Avenue Construction Impacts - Feb 1 - Feb 12

- North Avenue Construction Impacts - Jan 25 - Feb 5

- North Avenue Construction Impacts - Jan 19 - Jan 29

- North Avenue Construction Impacts - Jan 11 - Jan 22

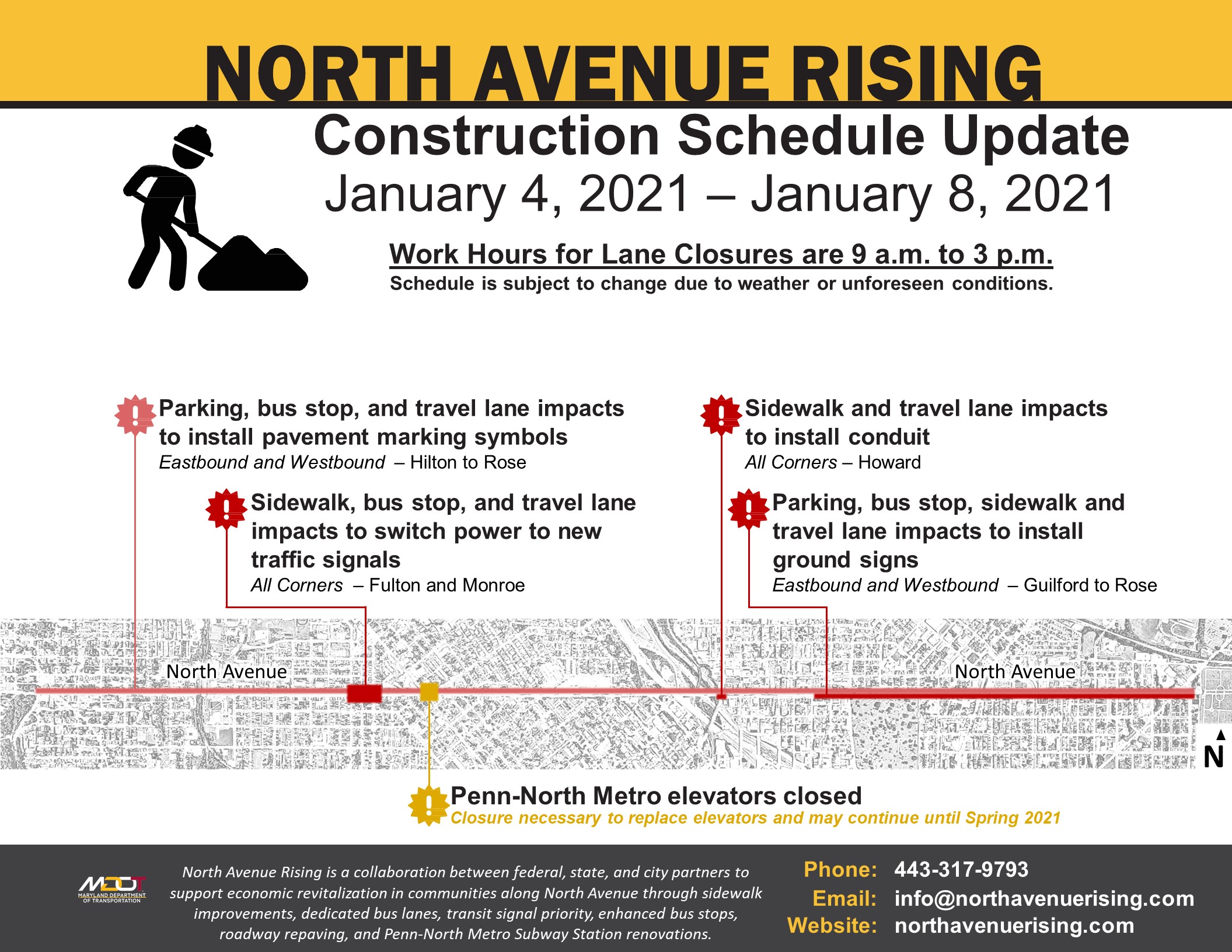

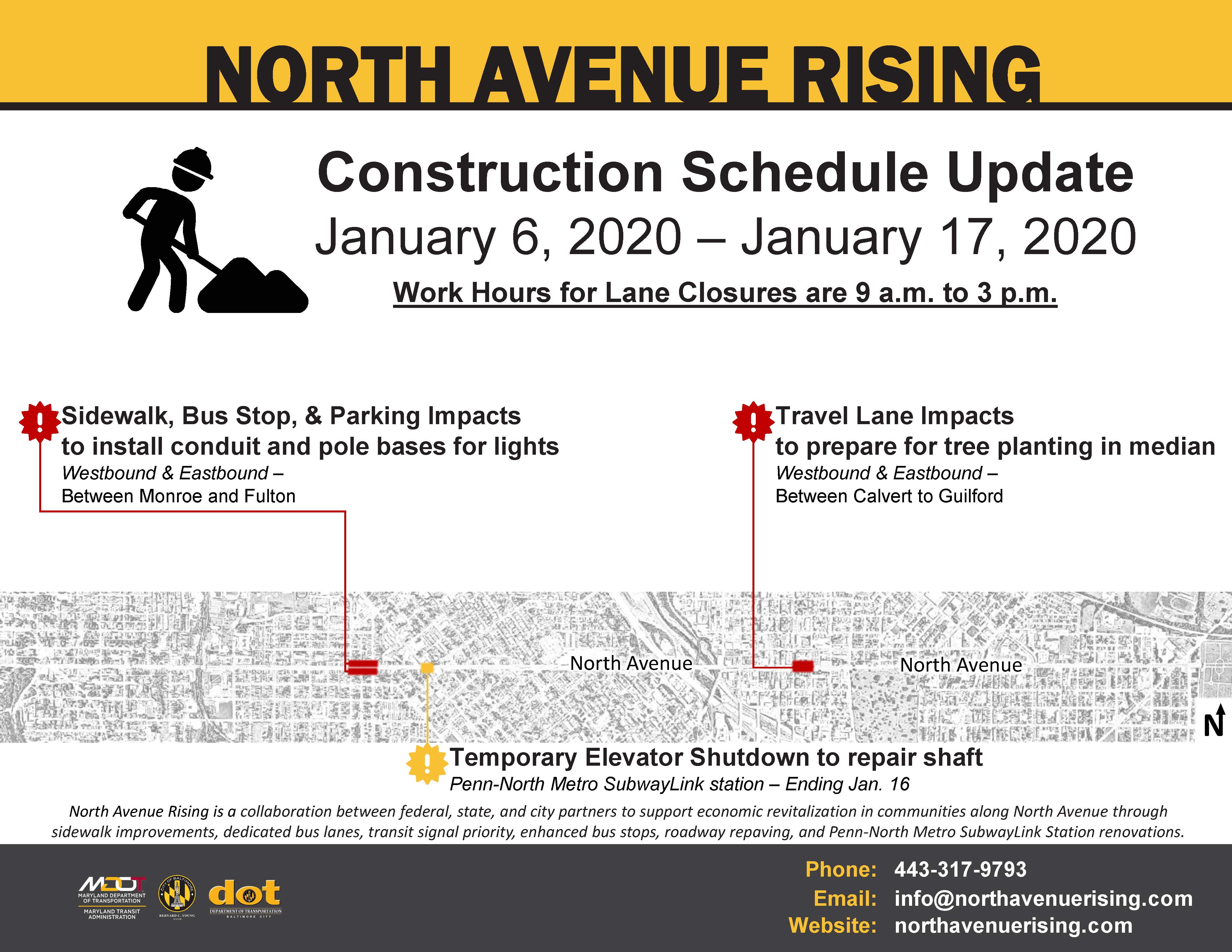

- North Avenue Construction Impacts - Jan 4 - Jan 8

2020
- West North Avenue Red Bus Lane & Repaving Flyer
(updated 8/28/2020) - East North Avenue Red Bus Lane & Repaving Flyer

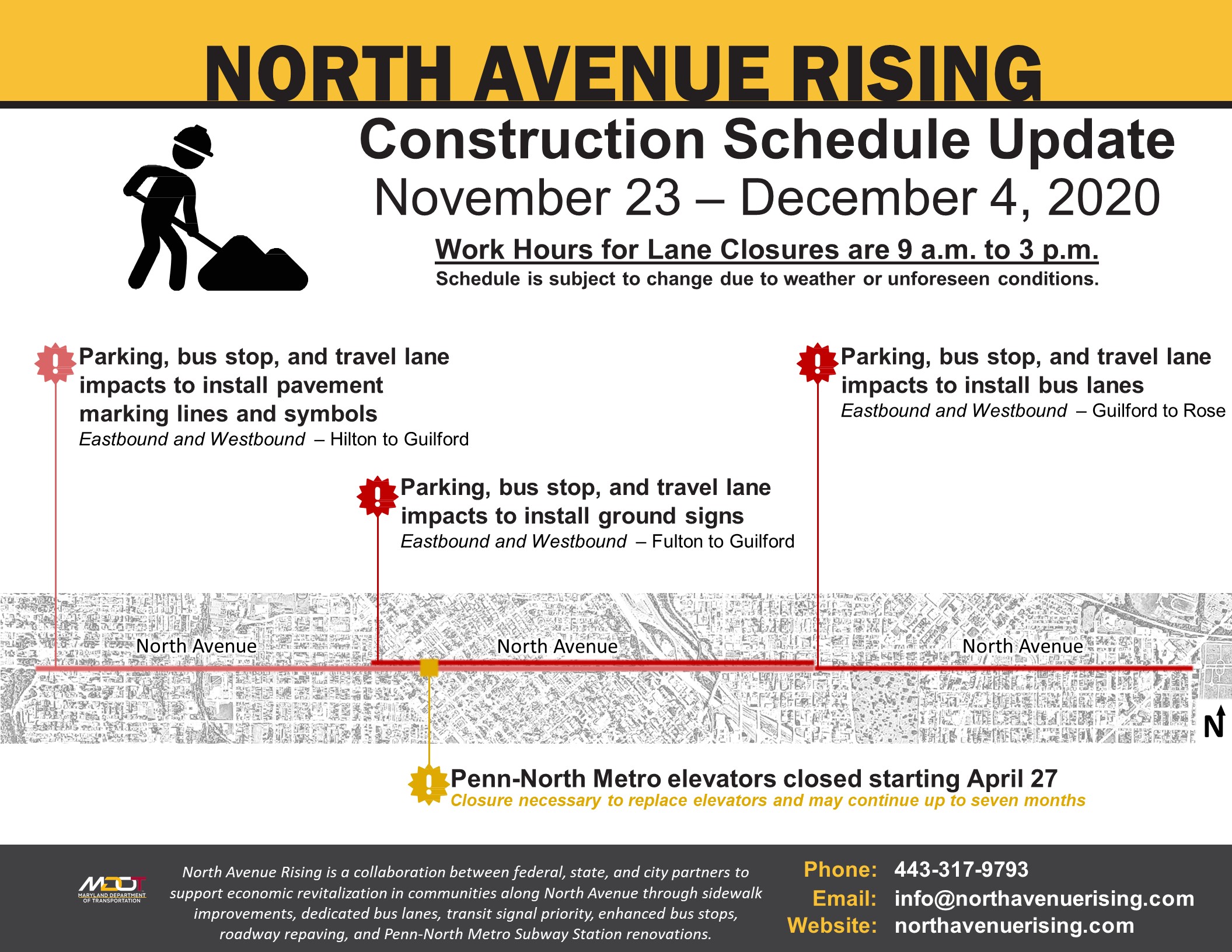

(updated 11/23/2020) - North Avenue Construction Impacts - Dec 28 - Jan 8

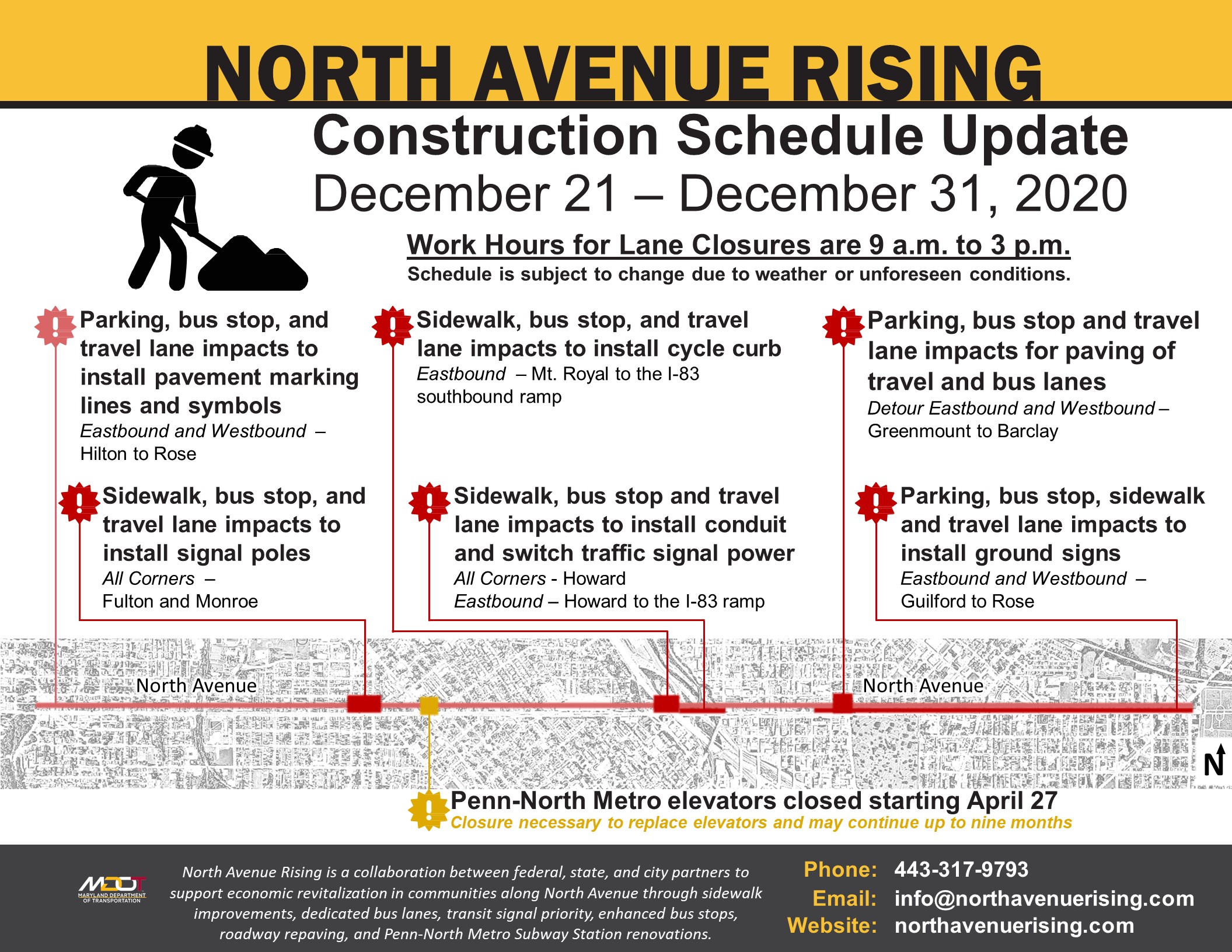

- North Avenue Construction Impacts - Dec 21 - Dec 31

- North Avenue Construction Impacts - Dec 14 - Dec 24

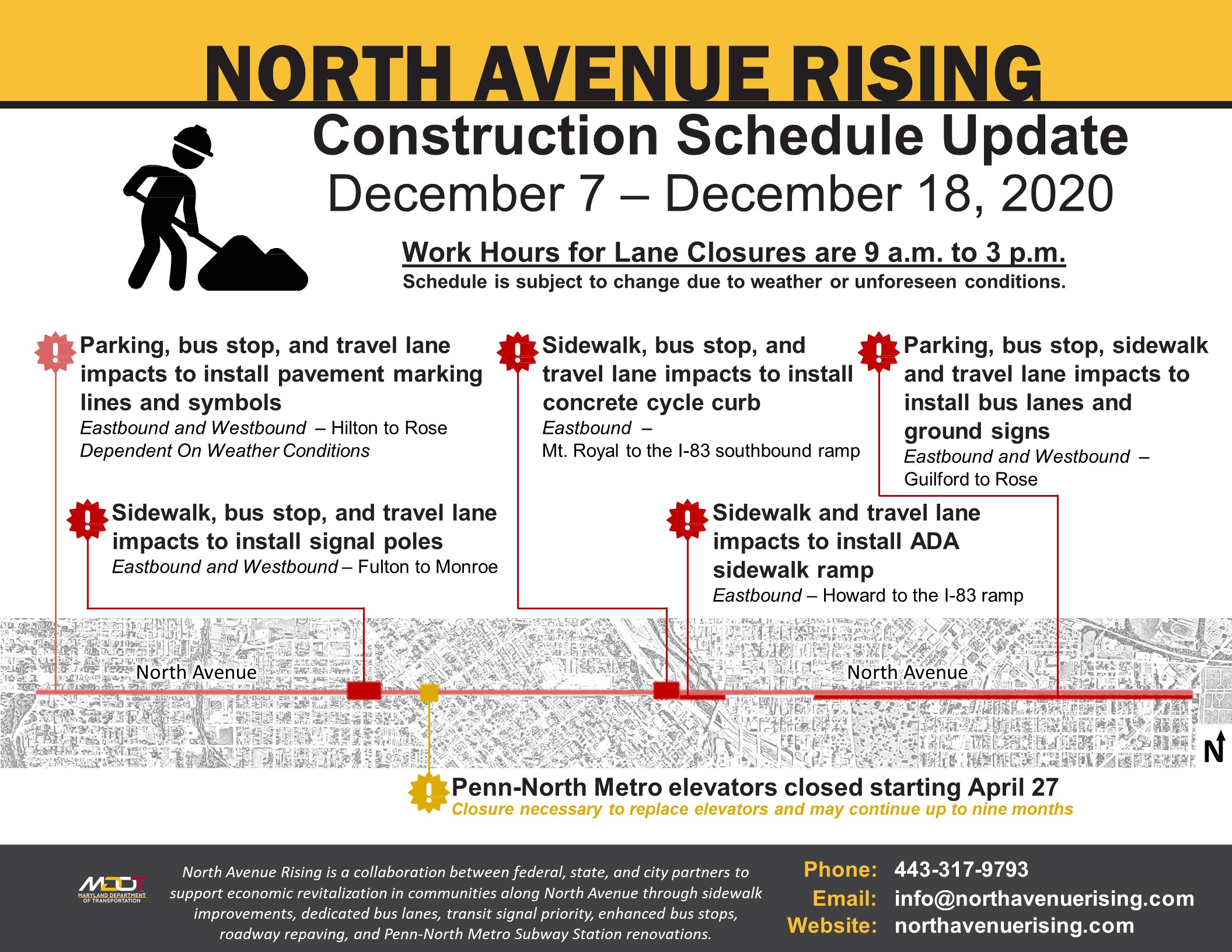

- North Avenue Construction Impacts - Dec 7 - Dec 18

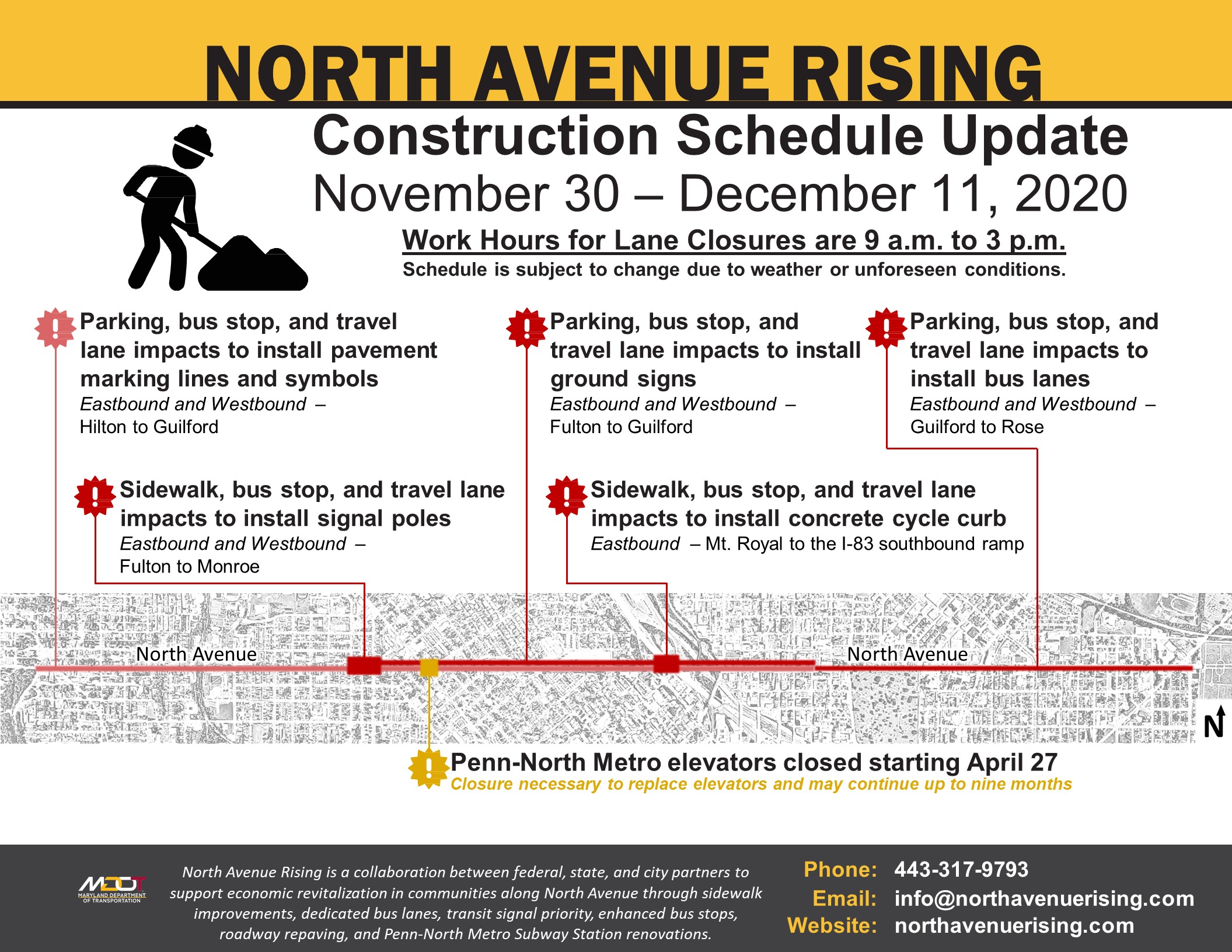

- North Avenue Construction Impacts - Nov 30 - Dec 11

- North Avenue Construction Impacts - Nov 23 - Dec 4

- North Avenue Construction Impacts - Nov 16 - Nov 25

- North Avenue Construction Impacts - Nov 9 - Nov 20

- North Avenue Construction Impacts - Nov 2 - Nov 13

- North Avenue Construction Impacts - Oct 26 - Nov 6

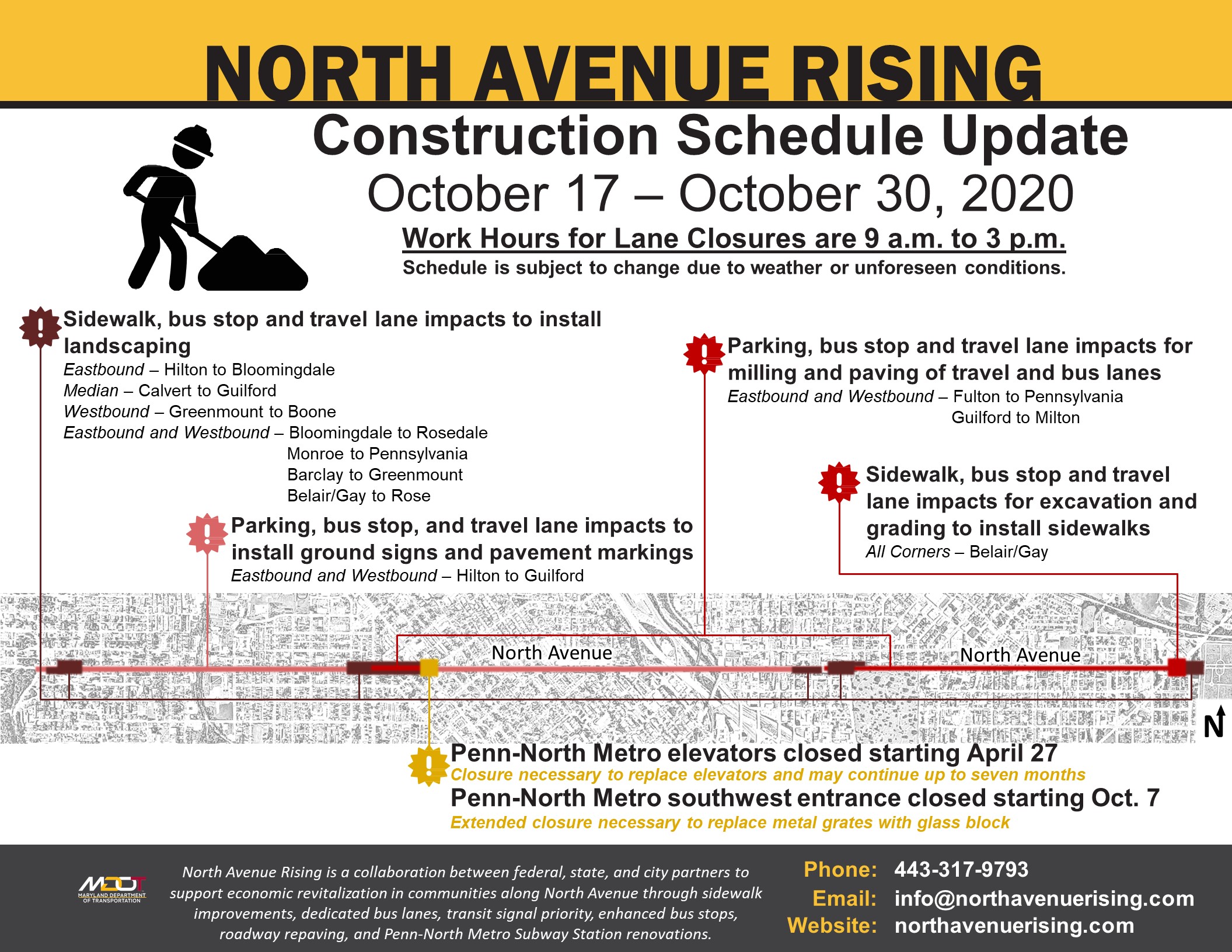

- North Avenue Construction Impacts - Oct 17 - Oct 30

- North Avenue Construction Impacts - Oct 10 - Oct 24

- North Avenue Construction Impacts - Oct 3 - Oct 17

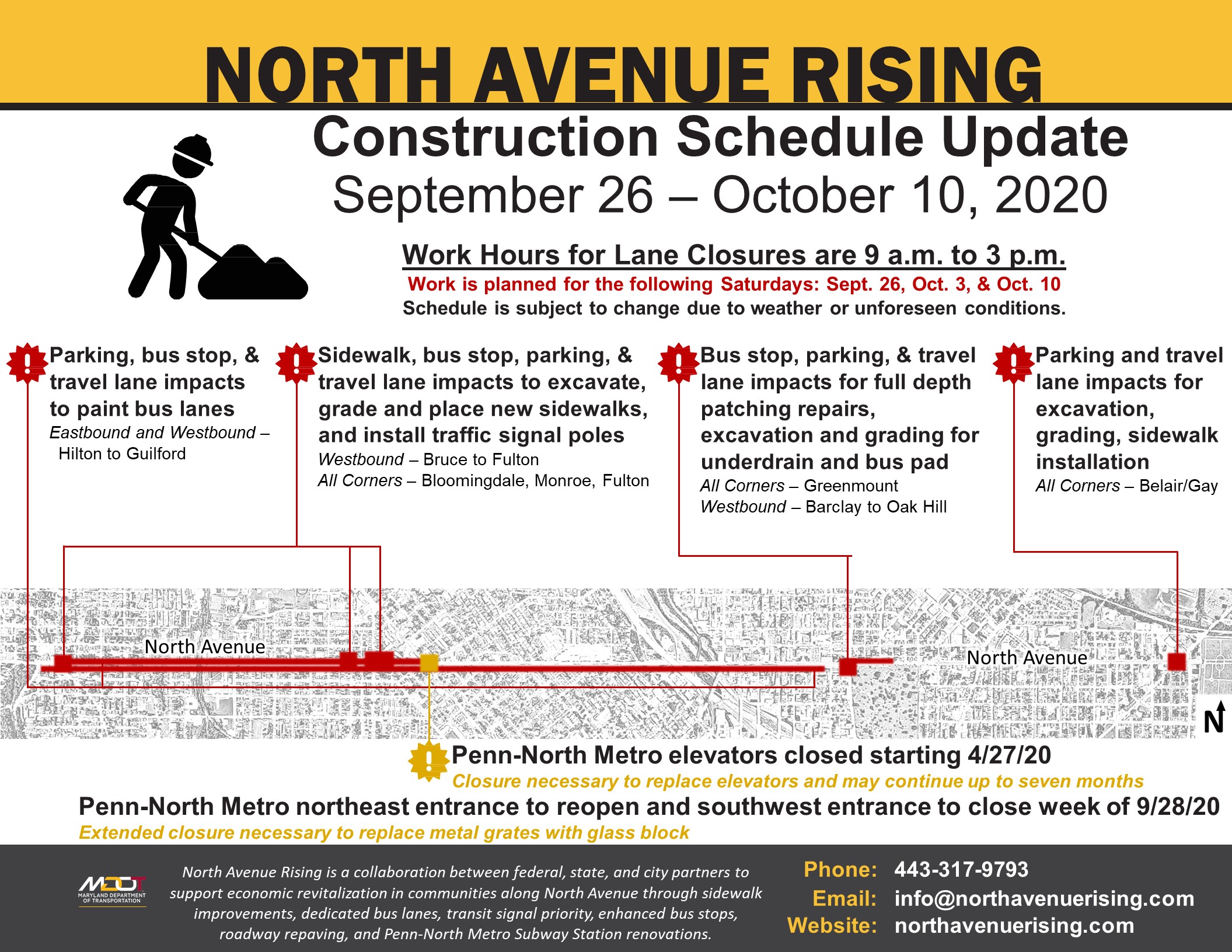

- North Avenue Construction Impacts - Sept 26 - Oct 10

- North Avenue Construction Impacts - Sept 12 - Sept 26

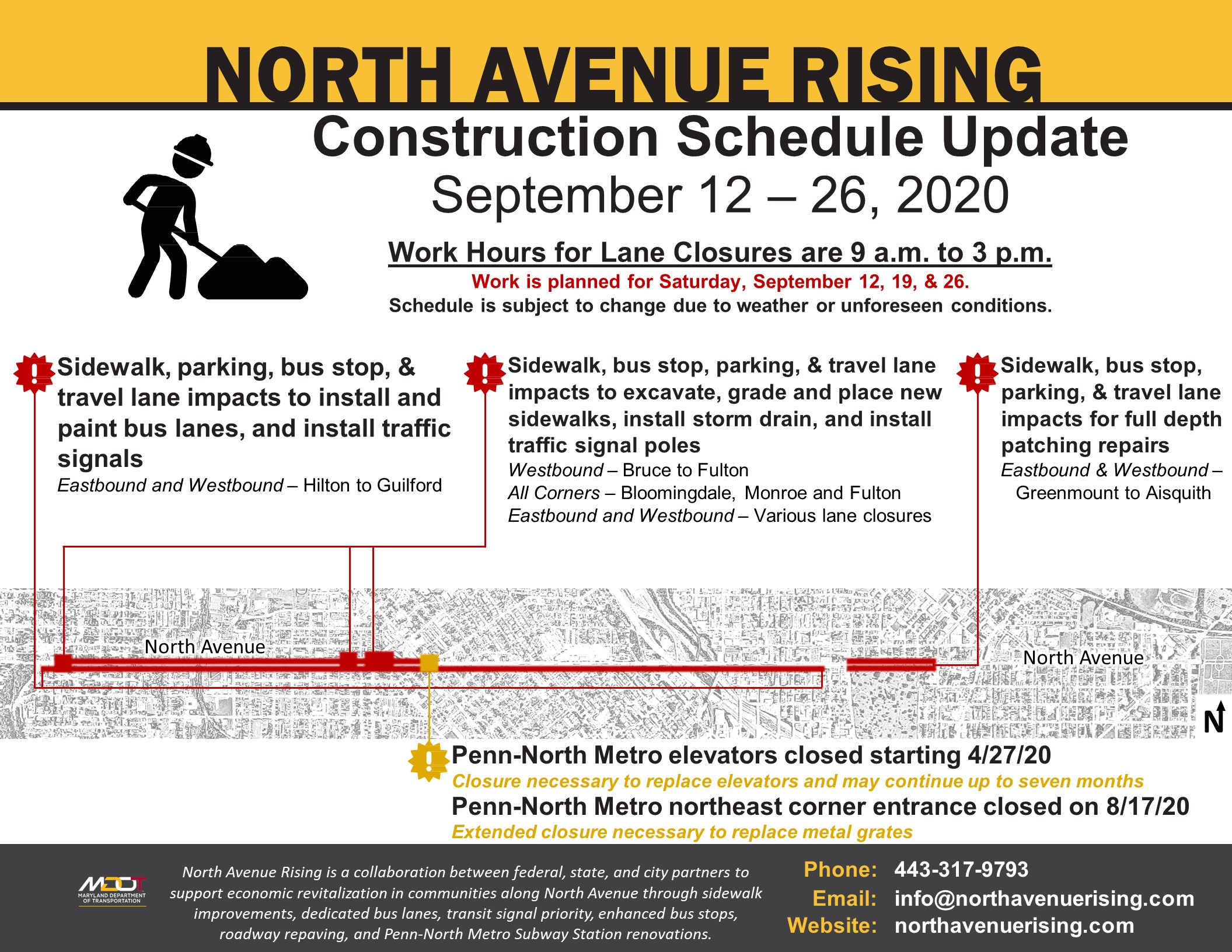

- North Avenue Construction Impacts - Sept 5 - Sept 19

- North Avenue Construction Impacts - Aug 31 - Sept 12

- West North Avenue Red Bus Lane & Repaving Flyer

- North Avenue Construction Impacts - Aug 15 - 29

- North Avenue Construction Impacts - Aug 8 - 22

- North Avenue Construction Impacts - Aug 1 - 15

- North Avenue Construction Impacts - July 25 - Aug. 8

- North Avenue Construction Impacts - July 11 - 25

- North Avenue Construction Impacts - July 6 - 18

- North Avenue Construction Impacts - June 29 - July 11

- North Avenue Construction Impacts - June 22 - July 3

- North Avenue Construction Impacts - June 13 - 27

- North Avenue Construction Impacts - June 6 - 20

- North Avenue Construction Impacts - May 30 - June 13

- North Avenue Construction Impacts - May 16 - 29

- North Avenue Construction Impacts - May 9 - 22

- North Avenue Construction Impacts - May 4 - 15

- North Avenue Construction Impacts - Apr. 27 - May 9

- North Avenue Construction Impacts - Apr. 20 - May 2

- North Avenue Construction Impacts - Apr. 13 - 24

- North Avenue Construction Impacts - Apr. 6 - 17

- North Avenue Construction Impacts - Mar. 30 - Apr. 10

- North Avenue Construction Impacts - Mar. 23 - Apr. 3

- North Avenue Construction Impacts - Mar. 16 - 27

- North Avenue Construction Impacts - Mar. 9 - 20

- North Avenue Construction Impacts - Mar. 2 - 13

- North Avenue Construction Impacts - Feb. 24 - Mar. 9

- North Avenue Construction Impacts - Feb. 17 - 28

- North Avenue Construction Impacts - Feb. 10 - 21

- North Avenue Construction Impacts - Feb. 3 - 14

- North Avenue Construction Impacts - Jan. 27 - Feb. 7

- North Avenue Construction Impacts - Jan. 20 - 31

- North Avenue Construction Impacts - Jan. 6 - 17

2019

- North Avenue Construction Impacts - Dec. 9 - 20

- North Avenue Construction Impacts - Nov. 25 - Dec. 6

- North Avenue Construction Impacts - Nov. 11 - 22

- North Avenue Construction Impacts - Nov. 4 - 15

- North Avenue Construction Impacts - Oct. 28 - Nov. 8

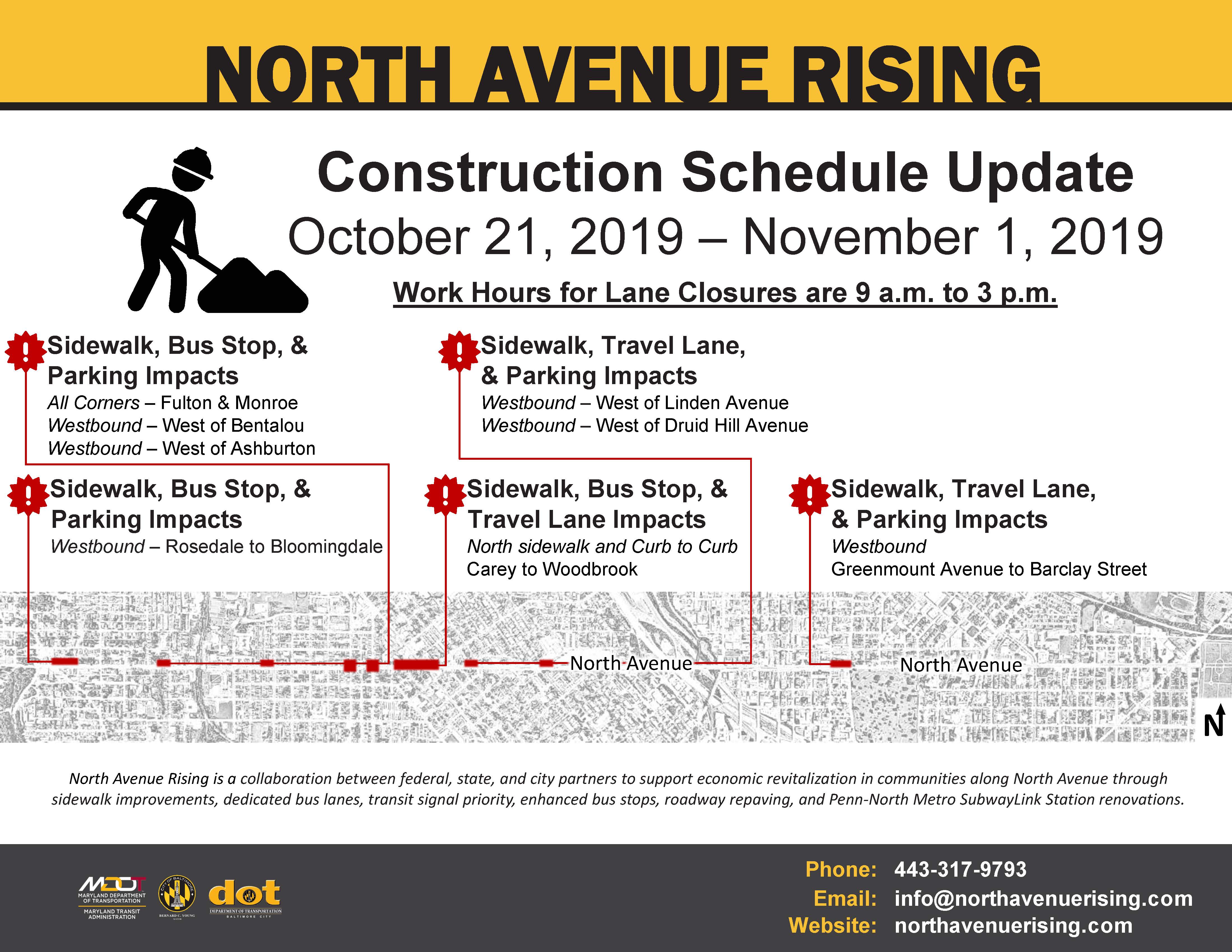

- North Avenue Construction Impacts - Oct. 21 - Nov. 1

- North Avenue Construction Impacts - Oct. 14-25

- North Avenue Construction Impacts - Oct. 7-18

- North Avenue Construction Impacts - Sept. 30 - Oct. 11

- North Avenue Construction Impacts - Sept. 23 - Oct. 4

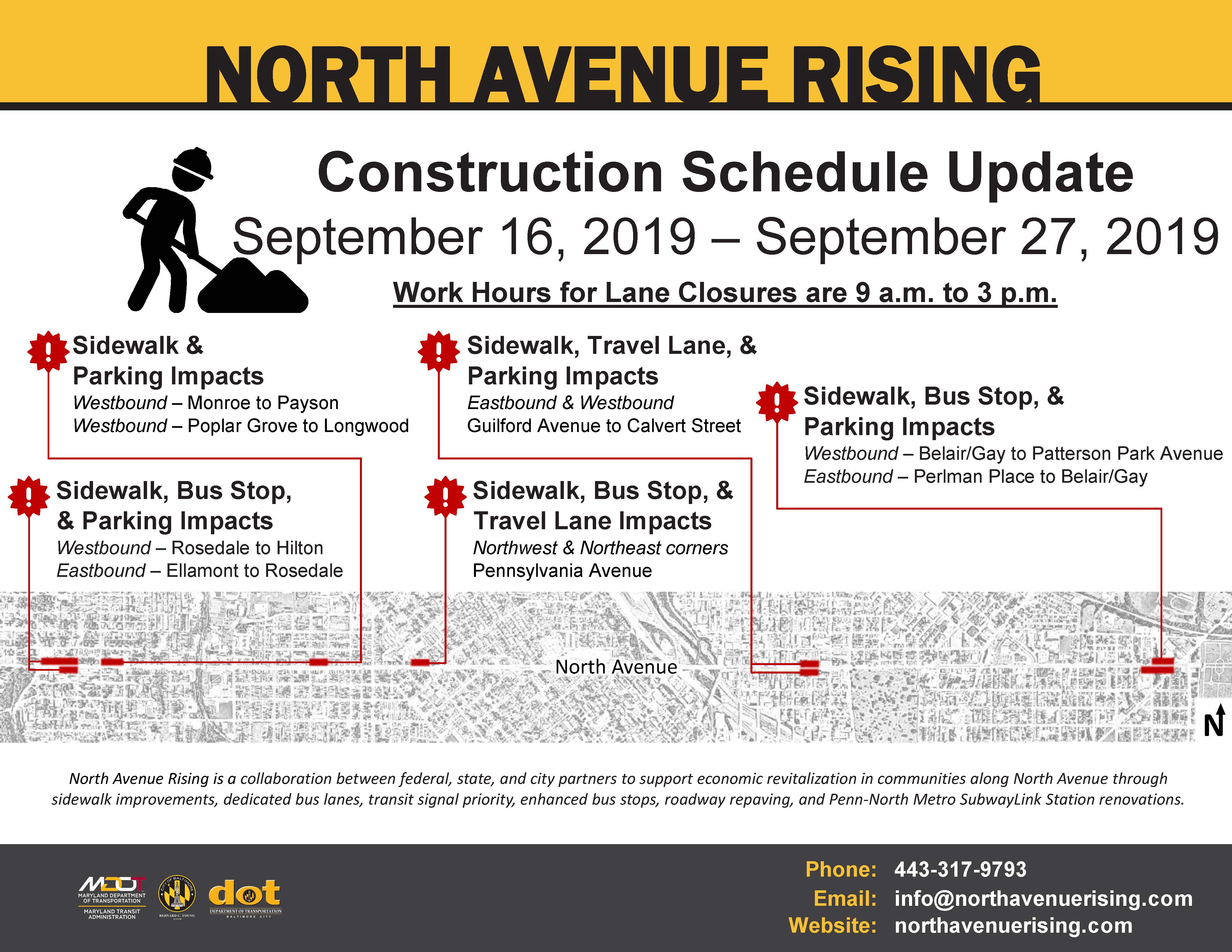

- North Avenue Construction Impacts - Sept. 16-27

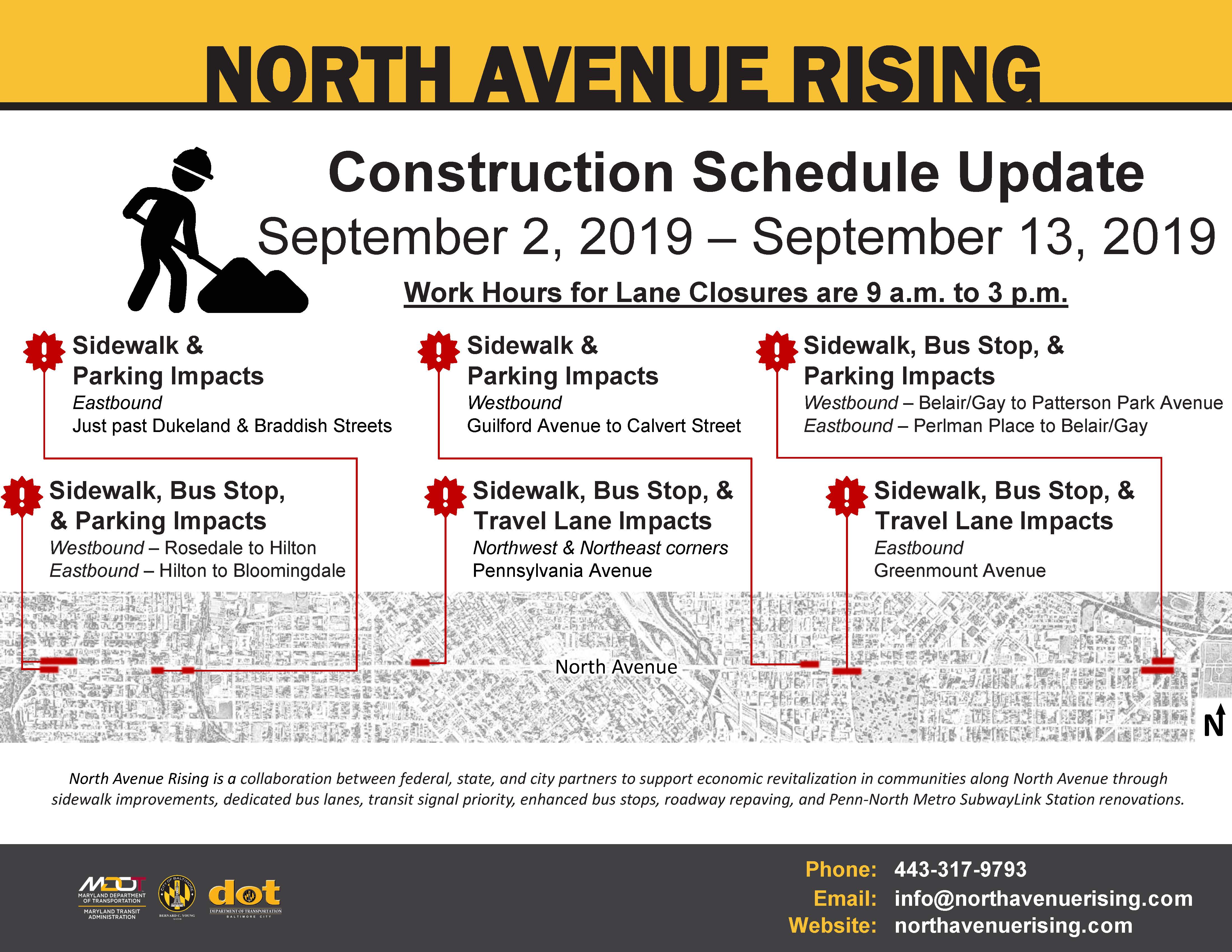

- North Avenue Construction Impacts - Sept. 2-13

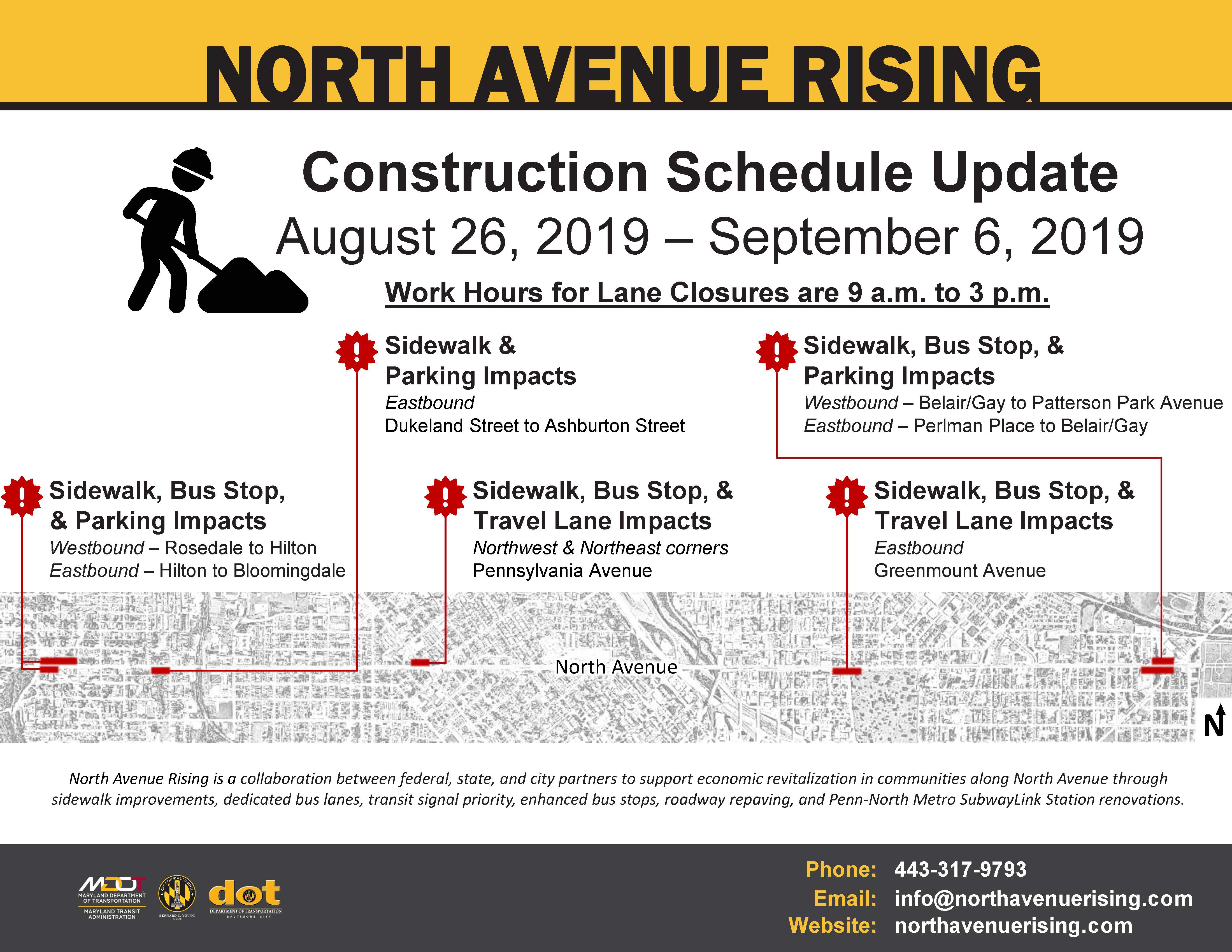

- North Avenue Construction Impacts - Aug. 26 - Sept. 6

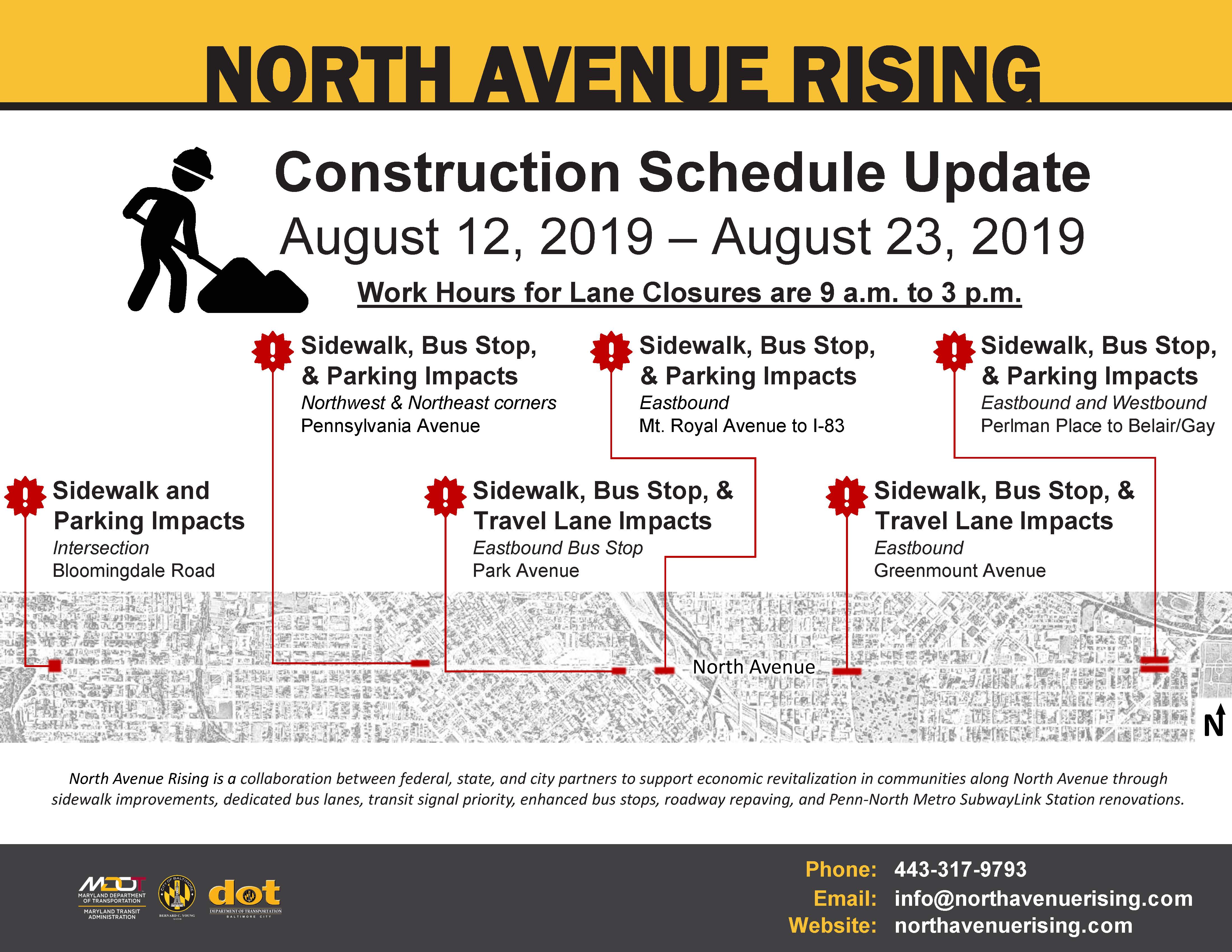

- North Avenue Construction Impacts - Aug. 12-23

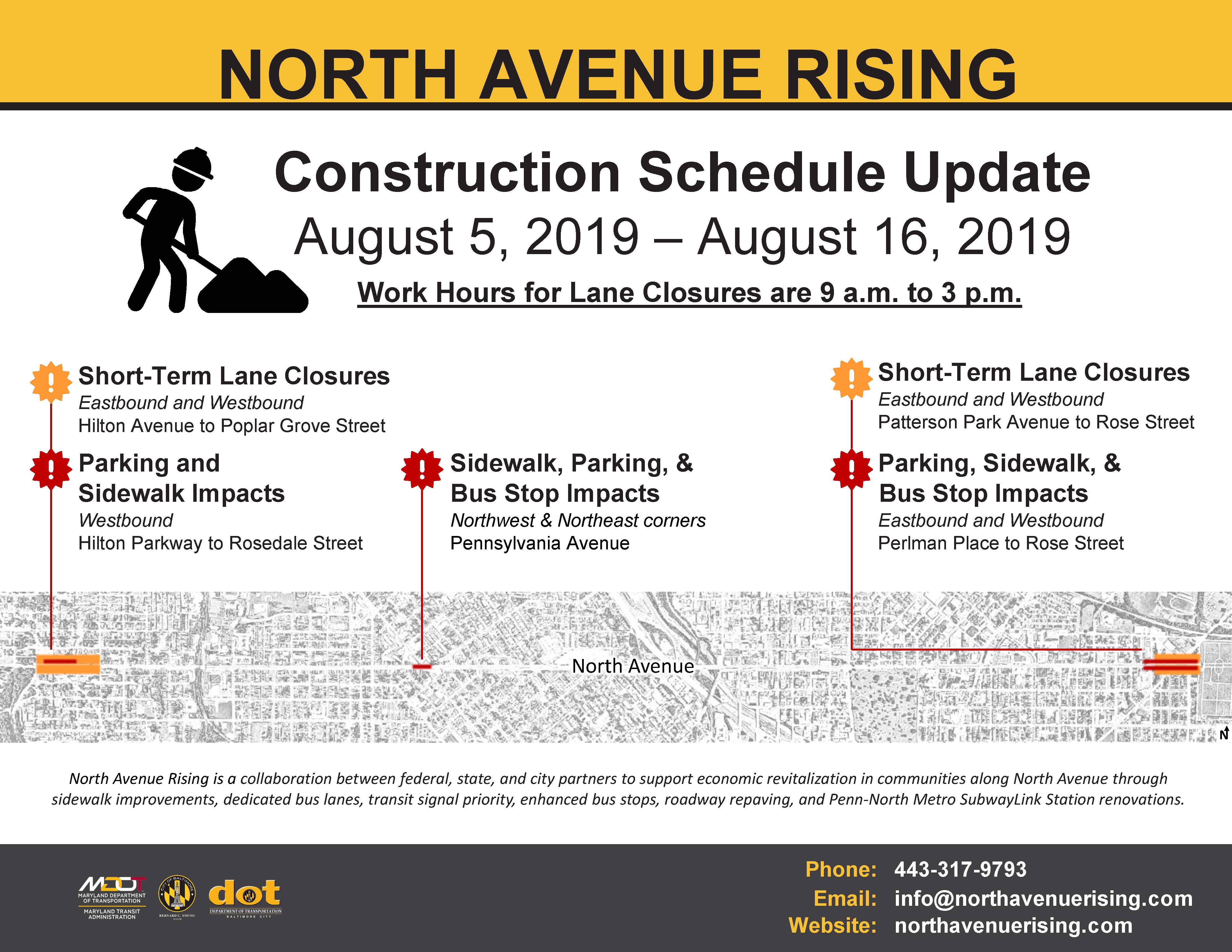

- North Avenue Construction Impacts - Aug. 5-16

Additional information about the work that was done at the intersection of Pennsylvania Avenue and North Avenue can be found at westnorthaveimprovements.com
Reach members of the project team at This email address is being protected from spambots. You need JavaScript enabled to view it. or by calling 443-317-9793.
Project Milestones
- Applied for TIGER grant in April 2016
- Award ceremony in August 2016
- The finalization of project design occurred in November 2018
- Construction started in the Summer of 2019
- Construction was planned to be completed by the end of the 2021 Calendar Year
- Construction completed in June 2022
